The manned reusable space system which was designed to slash the cost of space transport and replace all expendable launch vehicles. It did neither, but did keep NASA in the manned space flight business for 30 years (and counting...) Redesign of the shuttle with reliability in mind after the Challenger disaster reduced maximum payload to low earth orbit from 27,850 kg to 24,400 kg.
Launches: 100. Failures: 1. Success Rate: 99.00% pct. First Launch Date: 12 April 1981. Last Launch Date: 11 October 2000. LEO Payload: 24,400 kg. to: 204 km Orbit. at: 28.5 degrees. Payload: 12,500 kg. to a: space station orbit, 407 km, 51.6 deg inclination trajectory. Liftoff Thrust: 2,625,932 kgf. Total Mass: 2,029,633 kg. Core Diameter: 8.7 m. Total Length: 56.0 m. Development Cost $: 10,100.00 million. in 1977 average dollars. Launch Price $: 245.00 million. in 1988 price dollars. Total Production Built: 5. Flyaway Unit Cost $: 63.00 million. in 1988 unit dollars. Cost comments: Shuttle has high fixed costs and low marginal costs. Cost per mission dependent on rate. Flyaway cost is marginal cost for extra mission. Launch cost is cost per flight at 6 per year.
The Director of Apollo Test in the NASA Hq. Apollo Program Office, LeRoy E. Day, was detailed to head the MSF Space Shuttle Task Group. The group would provide NASA with material for a report on the Space Shuttle to the President's Space Task Group.
Two major directions were identified for manned space flight in the next decade. These were further exploration of the Moon, with possibly the establishment of a lunar surface base, and the continued development of manned flight in Earth orbit, leading to a permanent manned space station supported by a low-cost shuttle system. To maintain direction, the following key milestones were proposed: 1972 - AAP operations using a Saturn V launched Workshop 1973 - Start of post-Apollo lunar exploration 1974 - Start of suborbital flight tests of Earth to orbit shuttle - Launch of a second Saturn V Workshop 1975 - Initial space station operations - Orbital shuttle flights 1976 - Lunar orbit station - Full shuttle operations 1977 - Nuclear stage flight test 1978 - Nuclear shuttle operations-orbit to orbit 1979 - Space station in synchronous orbit By 1990 - Earth orbit space base - Lunar surface base - Possible Mars landing
Start structural assembly crew module, Enterprise (OV-101)
Start long-lead fabrication aft fuselage, Columbia (OV-102)
Complete final assembly and closeout system installation.
Boeing 747 shuttle carrier aircraft delivered to Edwards
Conduct first inert captive flight, Edwards (2 hours, 5 minutes), Enterprise (OV-101)
Conduct second inert captive flight, Edwards (3 hours, 13 minutes), Enterprise (OV-101)
Conduct third inert captive flight, Edwards (2 hours, 28 minutes), Enterprise (OV-101)
Conduct fourth inert captive flight, Edwards (2 hours, 11 minutes), Enterprise (OV-101)
Conduct fifth inert captive flight, Edwards (1 hour, 39 minutes), Enterprise (OV-101)
First manned captive active flight. Enterprise (OV-101)/shuttle carrier aircraft, Edwards (55 minutes, 46 seconds)
Second manned captive active flight. Enterprise (OV-101)/shuttle carrier aircraft, Edwards (1 hour, 2 minutes)
Third manned captive active flight. Enterprise (OV-101)/shuttle carrier aircraft, Edwards (59 minutes, 50 seconds)
Conduct first free flight, ALT, tail cone on, Edwards (5 minutes, 21 seconds), Enterprise (OV-101), lake bed Runway 17
Second free flight, ALT, tail cone on, Edwards (5 minutes, 28 seconds), Enterprise (OV-101), lake bed Runway 17
Third free flight , ALT, tail cone on, Edwards (5 minutes, 34 seconds), Enterprise (OV-101), lake bed Runway 15
Fourth free flight, ALT, first tail cone off, Edwards (2 minutes, 34 seconds), Enterprise (OV-101), lake bed Runway 17
Fifth free flight, ALT, final tail cone off, Edwards (2 minutes, 1 second), Enterprise (OV-101), concrete Runway 04
First ferry flight test, Edwards (3 hours, 21 minutes), Enterprise (OV-101)
Second ferry flight test, Edwards (4 hours, 17 minutes), Enterprise (OV-101)
Third ferry flight test, Edwards (4 hours, 13 minutes), Enterprise (OV-101)
Fourth ferry flight test, Edwards (3 hours, 37 minutes), Enterprise (OV-101)
Complete approach and landing flight tests, including ferry flights, Enterprise (OV-101)
Shuttle carrier aircraft/Columbia (OV-102) test flight at NASA Edwards
First flight of Space Transportation System (aka Space Shuttle).. Payloads: Development Flight Instrumentation and Aerodynamic Coefficient Identification Package. Additional Details: STS-1.
Second shuttle test flight. Payloads: Office of Space and Terrestrial Applications (OSTA)-1 experiments, Orbiter Experiments (OEX). Additional Details: STS-2.
Manned two crew. Payloads: Office of Space Science (OSS) experiments, Monodisperse Latex Reactor (MLR), Electro-phoresis Verification Test (EEVT), Plant Lignification Experiment. First and only landing by a shuttle at White Sands, New Mexico, after weather at Edwards did not permit landing there. Additional Details: STS-3.
Manned two crew. Fourth space shuttle test flight. Payloads: Induced Environment Contamination Monitor (IECM), Monodisperse Latex Reactor (MLR), Continuous Flow Electrophoresis System (CFES), Development Flight Instrumentation (DFl), Orbiter Experiments (OEX), first NASA getaway special (GAS), Night/Day Optical Survey of Lightning (NOSL) experiment, Vapor Phase Compression (VPC) freezer heat exchanger dynamics for freezing samples, Aerodynamic Coefficient Identification Package (AClP) experiment. Additional Details: STS-4.
Deployed from STS-5 11/11/82. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned four crew. First mission to deploy commercial communications satellites (SBS 3, Anik C3). Payloads: : Satellite Business Systems (SBS)-C with Payload Assist ; (PAM)-D; Telesat-E (Canadian communications satellite) with PAM-D. Monodisperse Latex Reactor (MLR), Continuous Flow Electrophoresis System (CFES), three getaway specials (GAS), Student experiments, GLOW experiment, Vestibular experiment, Oxygen Interaction With Materials experiment. Additional Details: STS-5.
Deployed from STS-5 11/11/82. Telecommunications. Operating entity Telesat Canada. Longitude 117.5W. Transmit power 11.2 W per frequency at input of transmit antenna (typical saturated carrier). Anik C-3 Transmit frequency (MHz): 11730, 11743, 11791, 11804, 11852 , 11865, 11913, 11926, 11974, 11987, 12035, 12048, 12096, 12109 , 12157, 12170.
Element of satellite communications network, deployed from STS-6 4/5/83. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned four crew. First flight of space shuttle Challenger; deployed TDRSS. Payloads: Deployment of Tracking and Data Relay Satellite (TDRS)-A with Inertial Upper Stage (lUS)-2, Continuous Flow Electrophoresis System (CFES), Monodisperse Latex Reactor (MLR), Night/Day Optical Survey of Lightning (NOSL) experiment, three getaway specials (GAS). Additional Details: STS-6.
Ten experiments mounted on Shuttle Pallet Satellite (SPAS-01) performed research in forming metal alloys in microgravity and use of remote sensing scanner. Orbiter's small control rockets fired while SPAS-01 held by remote manipulator system to test movement on extended arm.
Deployed by STS-7 6/19/83. Telecommunications. Operating entity TELESAT Canada. Longitude 110 W. Transmit power 11.2 W on each frequency. Frequencies 11730, 11743, 11791, 11804, 11852, 11865, 11913, 11926, 11974, 11987, 12035, 12048, 12096, 12109, 12157, 12170 MHz.
Manned five crew. Deployed Anik C2, Palapa B1; deployed and retrieved SPAS platform. Payloads: Office of Space and Terrestrial Applications (OSTA)-2 experiments, deployment of PALAPA-B1 communications satellite for Indonesia with Payload Assist Module (PAM)-D and Telesat-F communications satellite for Canada with PAM-D, German Shuttle Pallet Satellite (SPAS)-01, seven getaway specials (GAS), Monodisperse Latex Reactor (MLR), Continuous Flow Electrophoresis System (CFES). Additional Details: STS-7.
Deployed by STS-7 6/18/83. Palapa B satellites were four times as powerful and twice the size of their predecessors, the Palapa A series. While the A series was designed for domestic/regional communications within Indonesia, the new system also served the Philippines, Thailand, Malaysia and Singapore. Palapa B2 was originally placed into a useless orbit due to malfunctions of its PAM-D upper stage. The Indonesian government claimed $75 million insurance and ordered a replacement (B2P), which was successfully orbited 3 years later. The original B2 was recovered by the STS-51A mission on November 12, 1984 under an arrangement between the satellite's insurers, NASA and Hughes. The satellite was then sold by the insurers to an intermediary company, refurbished, and then resold back to Indonesia following its launch in 1990. Spacecraft: Based on Hughes HS-376 design. Cylindrical structure. Spin stabilised. Hydrazine propulsion system for attitude control, orbit maintenance. Body mounted solar cells provide 1060 W BOL. Despun antenna platform. Payload: Each carried 24 C-band transponders (+6 spares).
Released from STS 8 8/31/83; also carried transponders for domestic communications. Operational multipurpose satellite for telecommunications, meteorological imaging and data relay, radio and television programme distribution and direct television broadcasting for community reception. Geostationary longitude 74.0 +/ - 0.1 deg E. Deployment from US Space Transportation System flight no 8, orbiter Challenger, on 31 Aug 1983.
First night launch and night landing. Deployed Insat 1B. Payloads: Deployment of INSAT (lndia communica-tion satellite) with Payload Assist Module (PAM)-D, Payload Flight Test Article (PFTA)/ Payload Deployment Retrieval System (PDRS), Continuous Flow Electrophoresis (CFES), biomedical experiments. 250,000 express mail envelopes with special cachet for U.S. Postal Service were carried for a first-day cover. Additional Details: STS-8.
Carried ESA Spacelab. Payloads: Payload: Spacelab-1 experiments, habitable Spacelab and pallet, carried 71 experiments. The six-man crew was divided into two 12-hour-day red and blue teams to operate experiments. First high-inclination orbit of 57 degrees. Additional Details: STS-9.
![]() | Shuttle side view Credit: © Mark Wade. 7,022 bytes. 258 x 612 pixels. |
Manned five crew. Deployed Westar 6, Palapa B2; tested Manned Maneuvering Unit (MMU). Payloads: PALAPA-B2 (Indonesian communications satellite) with Payload Assist Module (PAM)-D and WESTAR (Western Union communications satellite)-Vl with PAM-D. Both satellites were deployed but the PAM-D in each satellite failed to ignite, leaving both satellites in earth orbit. Both satellites were retrieved and returned to earth for renovation on the STS-51-A mission. The manned maneuvering unit (MMU) was tested with extravehicular astronauts as free flyers without tethers as far as 98 m from the orbiter. Shuttle Pallet Satellite (SPAS)-01 experiments, Monodisperse Latex Reactor (MLR), Isoelectric Focusing Experiment (lEF), Acoustic Containerless Experiment System (ACES), Cinema 360 cameras, five getaway specials (GAS), Aerodynamic Coefficient Identification (ACIP)/High Resolution Accelerom-eter Package (HIRAP). Additional Details: STS-41-B.
Deployed from STS 41B 2/4/84; failed to reach proper orbit; recovered by STS-51A.
Deployed from STS 41B 2/4/84; failed to reach proper orbit; recovered by STS-51A. The Westar series of geostationary spacecraft provide commercial communications services for Western Union. Westar 6 failed to achieve geosynchronous orbit after being deployed from the Space Shuttle. It was later retrieved by another Shuttle mission (November 14, 1984) and returned for refurbishment and relaunch. All Westars have been launched by NASA on a reimbursable basis. Spacecraft: Westar uses the Hughes HS-376 spacecraft design. Spin stabilised with a despun antenna section. Body mounted solar cells. Once on orbit, an outer cylinder deploys downward in 'dixie-cup' fashion to increase the solar panel area. Payload: Westar spacecraft typically carried 12 to 24 transponders in the 4-6 GHz range. A single antenna reflector (72 inch diameter) is used with an array of offset feed horns. The reflector uses two polarisation-selective surfaces for horizontal and vertical polarised signals.
Deployed from STS 41B 2/5/84; Integrated Rendezvous Target. Spent boosters, spent maneuvering stages, shrouds and other non-functional objects (US Cat D).
German-built Shuttle Pallet Satellite (SPAS), first flown on STS-7, became first satellite refurbished and flown again. SPAS remained in payload bay due to electrical problem with Remote Manipulator System (RMS).
Manned five crew. First repair on orbit of a satellite, Solar Maximum Mission, by James van Hoften and George Nelson. Deployed LDEF. Payloads:Solar Maximum Mission (SMM) repair, manned maneuvering unit (MMU) satellite support, deployment of Long-Duration Exposure Facility (LDEF) in earth orbit free drift. LDEF contained 57 experiments and weighed about 10,000 kg. Cinema 360 and IMAX 70-mm cameras. Additional Details: STS-41-C.
Long Duration Exposure Facility; deployed from STS 41C 4/7/84; retrieved by STS-32 1/20/90. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
Manned six crew. First flight of space shuttle Discovery; deployed SBS 4, Leasat 1, Telstar 3C. Payloads: Satellite Business System (SBS)-D commu-nications satellite with Payload Assist Module (PAM)-D deployment, Syncom IV-2 communica-tions satellite with its unique stage deployment, Telstar (American Telephone and Telegraph) 3-C with PAM-D deployment, Office of Aeronautics and Space Technology (OAST)-1 experiments. Deployment and restowing of large solar array. Continuous Flow Electrophoresis (CFES). IMAX camera. Additional Details: STS-41-D.
Released from STS 41D 8/31/84; 101 deg W. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Released from STS 41D 8/31/84; 105 deg W; leased to U.S. government. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Released from STS 41D 9/1/84; stationed at 125 deg W. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Earth Radiation Budget Satellite. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
Manned seven crew. Deployed ERBS; performed high resolution Earth imagery. Payloads: Earth Radiation Budget Satellite (ERBS) deployment, Office of Space and Terrestrial Applications (OSTA)-3 experiments, Large Format Camera (LFC). First use of Orbital Refueling System (ORS) with extravehicular activity (EVA) astronauts, IMAX camera. In response to the American Strategic Defence Initiative and continued military use of the shuttle, the Soviet Union fired a 'warning shot' from the Terra-3 laser complex at Sary Shagan. The facility tracked Challenger with a low power laser on 10 October 1984. This caused malfunctions to on-board equipment and discomfort / temporary blinding of the crew, leading to a US diplomatic protest. Additional Details: STS-41-G.
Manned five crew. First retrieval of two satellites (PALAPA B-2 and WESTAR Vl) for return to earth. Deployed Anik D2, Leasat 2; recovered Westar 6, Palapa B2. Payloads: Telesat (Canada communications satellite)-H with Payload Assist Module (PAM)-D deploy-ment, Syncom IV-1 communications satellite deployment with its unique stage, retrieval of PALAPA B-2 and WESTAR VI communications satellites with PAM-D which failed to ignite on the STS-41-B mission. Manned maneuvering unit (MMU) used for retrieval. Diffusive Mixing of Organic Solutions (DMOS) experiment. Additional Details: STS-51-A.
Released 11/9/84 from STS 51A; 82 deg W. Telecommunications. Longitude 111.5 deg W. Operating entity Telesat Canada. Transmitter power 8.9 watts at each frequency. Frequencies 3720 to 4180 MHz spaced by 20 MHz.
Released from STS 51A 11/10/84; 105 deg W; leased to U.S. government. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned five crew. Deployed USA 8 (Aquacade ELINT spacecraft). Orbits of Earth: 48. Landed at: Runway 15 at Kennedy Space Center, Florida. Landing Speed: 342 kph. Touchdown miss distance: 839.00 m. Landing Rollout: 2,240.00 m. Payloads: Department of Defence classified payloads. Additional Details: STS-51-C.
New Magnum model geostationary ELINT satellite model replaced earlier Rhyolite/Aquacade. Deployed from STS-51C January 24 1985. Boosted to geostationary orbit.
Released by STS 51D 4/13/85; 107.5 deg W. Telecommunications. Operating entity TELESAT Canada. Longitude 107.5 W. Transmit power 11.2 W on each frequency. Frequencies 11730, 11743, 11791, 11804, 11852, 11865, 11913, 11926, 11974, 11987, 12035, 12048, 12096, 12109, 12157, 121 70 MHz.
Released by STS 51D 4/13/85; failed to orbit and subsequently repaired by STS 51-I on 8/31/85; 178 deg E; leased by U.S. government. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned seven crew. Payloads: Telesat (Canada communications satellite)-I with Payload Assist Module (PAM)-D deployment, Syncom IV-3 communications satellite deploy-ment with its unique stage (unique stage failed to ignite), Continuous Flow Electrophoresis (CFES), Phase Partitioning Experiment (PPE), student experiments, two getaway specials (GAS) Informal science studies (Toys in Space). Additional Details: STS-51-D.
Air traffic control radar calibration. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned seven crew. Deployed Nusat; carried Spacelab 3. Payloads: Spacelab-3 experiments, habitable Spacelab and mission peculiar experiment support structure. The experiments represented a total of five different disciplines: materials processing in space, environmental observa-tions, life science, astrophysics, and technology experiments. Two getaway specials (GAS). The flight crew was split into gold and silver shifts working 12-hour days during the flight. Additional Details: STS-51-B.
Released by STS 51G 6/19/85; stationed at 76 deg W.
Deployed and retrieved Spartan 1; launched Morelos 1, Arabsat 1B, Telstar 3D.Payloads: Shuttle Pointed Autono-mous Research Tool for Astronomy (SPARTAN)-1; Automated Directional Solidification Furnace (ADSF); High Precision Tracking Experiment (HPTE); Orbiter Experiments (OEX); French Echocardiograph Experiment (FEE) and French Pocket Experiment (FPE). Additional Details: STS-51-G.
Released by STS 51G 6/17/85; 113.5 deg W. Coverage of the national territory with television, radio and telephony signals and data transmission. Geostationary satellite.
Released by STS 51G 6/18/85; 26 deg E.
Released by STS 51G 6/20/85, retrieved 6/22/85.
Plasma Diagnostics Package; released by STS 51F 8/1/85, retrieved 8/2/85.
Manned seven crew. At 5 minutes, 45 seconds into ascent the number one engine shut down prematurely and an abort to orbit was declared. Despite the anomaly the mission continued. Launched PDP; carried Spacelab 2. Payloads: Spacelab-2 with 13 experiments, Shuttle Amateur Radio Experiment (SAREX), Protein Crystal Growth (PCG). The flight crew was divided into a red and blue team. Each team worked 12-hour shifts for 24-hour-a-day operation. Additional Details: STS-51-F.
Manned five crew. Launched Aussat 1, ASC 1, Leasat 4; repaired Leasat 3. Payloads: Deploy ASC (American Satellite Company)-1 with Payload Assist Modue (PAM)-D. Deploy AUSSAT (Australian communications satellite)-1 with PAM-D. Deploy Syncom IV-4 communications satellite with its unique stage. Retrieve Leasat-3 communications satellite, repair and deploy by extravehicular activity (EVA) astronauts. Physical Vapor Transport Organic Solids (PVTOS) experiment. Additional Details: STS-51-I.
Released by STS 51I 8/27/85. Aussat A1 was decommissioned in early 1993 at the ned of its nominal life. It is currently in a non-synchronous graveyard orbit.. It spent its active life at 160 deg. E.
Released by STS 51I 8/27/85; stationed at 81 deg E. C, Ku band communications satellite.
Released by STS 51I 8/29/85; 178 deg E; leased by U.S. government. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned five crew. Atlantis (first flight); deployed USA 11, USA 12. Reusable space transportation system.
Orbits of Earth: 63. Landed at: Runway 23 dry lake bed at Edwards Air Force Base, . Touchdown miss distance: 754.00 m. Landing Rollout: 2,455.00 m. Payloads: Classified DoD Mission - Record altitude (as of 5/93). Additional Details: STS-51-J.

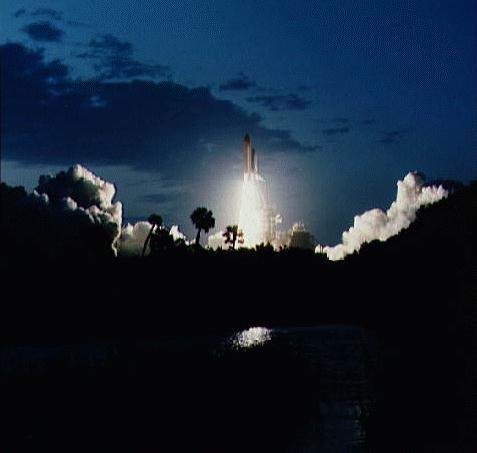

![]() | Shuttle Night Launch Credit: NASA. 15,622 bytes. 477 x 453 pixels. |
Released from STS 51J 10/4/85; boosted into orbit with DSCS 3 F3 on single IUS booster. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Released from STS 61A 11/1/85. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
Manned eight crew. Launched GLOMR; carried Spacelab D1. Payloads: Spacelab D-1 with habitable module and 76 experiments. Six of the eight crew members were divided into a blue and red team working 12-hour shifts for 24-hour-a-day operation. The remaining two crew members were 'switch hitters.'. Additional Details: STS-61-A.
Planned EOM-1/2 shuttle mission. Cancelled due to payload delays.
Manned seven crew. Deployed Morelos 2, Aussat 2, Satcom K2, OEX. Payloads: Deploy SATCOM (RCA-Satellite Communi-cations) Ku-2 with Payload Assist Module (PAM)-D II. Deploy Morelos (Mexico communications satellite)-B with PAM-D. Deploy AUSSAT (Australian communications satellite)-2 with PAM-D. EASE/ACCESS (Assembly of Structures� Assembly Concept for Construction of Erectable Space Structures) by extravehicular activity (EVA) astronauts, Continuous Flow Electrophore-sis System (CFES), Diffusive Mixing of Organic Solutions (DMOS), IMAX camera, one getaway special (GAS), Linhof camera and Hasseblad camera. Additional Details: STS-61-B.
Released by STS 61B 11/27/85. Coverage of the national territory with television, radio and telephony signals and data transmission. Geostationary satellite.
Released by STS 61B 11/28/85; 156 deg E.
Released by STS 61B 11/28/85; 81 deg W.
Released from STS 61B 11/30/85; shuttle autopilot software test target. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Stationed at 81 deg W.
Manned seven crew. Launched Satcom K1. Payloads: Deploy SATCOM (RCA-Satellite Communi-cations) Ku-1 with Payload Assist Module (PAM)-D II. Materials Science Laboratory, Comet Halley Active Monitoring Experiment (CHAMP), Hitchhiker (HH) Goddard (G)-1, thirteen getaway specials (GAS), student experiment, Initial Blood Storage Equipment (lBSE), Characterization of Space Motion Sickness (SMS). Additional Details: STS-61-C.
Exploded 73 seconds after launch, all 7 crewmembers were killed; carried TDRSS satellite. Additional Details: STS-51-L.
Planned Spacelab-D1 shuttle mission. Cancelled after Challenger disaster. No crew selected; renamed STS-61A
Manned five crew. First shuttle reflight after Challenger disaster. Deployed TDRS 3. Payloads: Deploy IUS (lnertial Upper Stage) with Tracking and Data Relay Satellite (TDRS)-C. 3M's Physical Vapor Transport Organics Solids 2 experiment (PVTOS), Automated Directional Solidification Furnace (ADSF), Infrared Communi-cations Flight Experiment (lRCFE), Protein Crystal Growth Il (PCG), Isoelectric Focusing (ISF)-2, Phase Partitioning Experiment (PPE), Aggrega-tion of Red Blood Cells (ARC)-2, Mesoscale Lightning Experiment (MLE)-1, Earth Limb Radiance (ELRAD), Orbiter Experiments (OEX), Autonomous Supporting Instrumentation System (OASlS)-I, two Shuttle Student Involvement Project (SSIP) experiments. Additional Details: STS-26.
NASA communications; 171 deg W; deployed from STS-26 . Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned five crew. Deployed a classified payload. Orbits of Earth: 68. Landed at: Runway 17 dry lake bed at Edwards Air Force Base, . Landing Speed: 359 kph. Touchdown miss distance: 447.00 m. Landing Rollout: 2,171.00 m. Payloads: DoD Mission. Additional Details: STS-27.
Deployed from STS-27. Operations completed March 1997.
Manned five crew. Deployed TDRS 4. Payloads: Deploy IUS (Inertial Upper Stage) with Tracking and Data Relay Satellite (TDRS)-D. Protein Crystal Growth (PCG); Chromosome and Plant Cell Division in Space; IMAX 70mm camera; Shuttle Student Involvement Project (SSIP) experiments: SSIP 82-8, Effects of Weightlessness in Space Flight on the Healing of Bone Fractures, and SSIP 83-9, Chicken Embryo Development in Space; Air Force Maui Optical Site (AMOS) experiment. Additional Details: STS-29.
Deployed from STS 29 3/13/89; NASA communications; 41 deg W. Spacecraft engaged in practical applications and uses of space technology such as weather or communication (US Cat C).
Manned five crew. Deployed Magellan Venus probe. Payloads: Deploy IUS with Magellan spacecraft. Fluids Experiment Apparatus (FEA). Mesoscale Lightning Experiment (MLE), Air Force Maui Optical Site (AMOS) experiment. Additional Details: STS-30.
SAR radar imaging of the Venusian surface, gravitational field mapping. The Magellan spacecraft was deployed from shuttle STS-30 on May 5, 1989, arrived at Venus on August 10, 1990 and was inserted into a near-polar elliptical orbit with a periapsis altitude of 294 km at 9.5 deg. N. The primary objectives of the Magellan mission were to map the surface of Venus with a synthetic aperture radar (SAR) and to determine the topographic relief of the planet. At the completion of radar mapping 98% of the surface was imaged at resolutions better than 100 m, and many areas were imaged multiple times. The mission was divided up into 'cycles', each cycle lasted 243 days (the time necessary for Venus to rotate once under the Magellan orbit - i.e. the time necessary for Magellan to 'see' the entire surface once.) The mission proceeded as follows: 10 Aug 1990 - Venus orbit insertion and spacecraft checkout;15 Sep 1990 - Cycle 1: Radar mapping (left-looking); 15 May 1991 - Cycle 2: Radar mapping (right-looking); 15 Jan 1992 - Cycle 3: Radar mapping (left-looking); 14 Sep 1992 - Cycle 4: Gravity data acquisition; 24 May 1993 - Aerobraking to circular orbit; 3 Aug 1993 - Cycle 5: Gravity data acquisition; 30 Aug 1994 - Windmill experiment; 12 Oct 1994 - Loss of radio signal; 13 Oct 1994 - Loss of spacecraft. A total of 4225 usable SAR imaging orbits was obtained by Magellan. Magellan showed an Earth-sized planet with no evidence of Earth-like plate tectonics. At least 85% of the surface is covered with volcanic flows, the remainder by highly deformed mountain belts. Even with the high surface temperature (475 C) and high atmospheric pressure (92 bars), the complete lack of water makes erosion a negligibly slow process, and surface features can persist for hundreds of millions of years. Some surface modification in the form of wind streaks was observed. Over 80% of Venus lies within 1 km of the mean radius of 6051.84 km. The mean surface age is estimated to be about 500 million years. A major unanswered question concerns whether the entire surface was covered in a series of large events 500 million years ago, or if it has been covered slowly over time. The gravity field of Venus is highly correlated with the surface topography, which indicates the mechanism of topographic support is unlike the Earth, and may be controlled by processes deep in the interior. Details of the global tectonics on Venus were still unresolved.
Deployed from STS-28 8/8/89.
Manned five crew. Deployed 2 classified satellites. Landed at: Runway 17 dry lake bed at Edwards Air Force Base, . Landing Speed: 287 kph. Touchdown miss distance: 1,618.00 m. Landing Rollout: 1,833.00 m. Payloads: DoD Mission. Additional Details: STS-28.
Deployed from STS-28 8/8/89. Believed to be one-off ferret satellite under COBRA BRASS measurement and signature intelligence experiment.
Manned five crew. Deployed Galileo .Payloads: Deploy IUS with Galileo spacecraft. Shuttle Solar Backscatter Ultraviolet (SSBUV), Polymer Morphology (PM) experiments, IMAX camera project, Mesoscale Lightning Experiment (MLE), Air Force Maui Optical Site (AMOS) experiment, Growth Hormone Concentration and Distribution (GHCD) in Plants experiment, Sensor Technology Experiment (STEX), SSIP Student Experiment (SE) 82-15, Ice Crystals Experiment. First flight at this inclination. Additional Details: STS-34.
Deployed from STS-34 10/18/89; entered Jupiter orbit 12/7/95; investigations of Jupiter's moons, atmosphere, magnetosphere; antenna failed to deploy. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
Atmospheric probe; deployed from Galileo 7/13/95; entered Jupiter atmosphere 12/7/95. Entry into Jupiter Dec 7
Manned five crew. Deployed a classified payload. Orbits of Earth: 78. Distance traveled: 3,218,687 km. Landed at: Concrete runway 04 at Edwards Air Force Base, Cali. Landing Speed: 368 kph. Touchdown miss distance: 570.00 m. Landing Rollout: 2,366.00 m. Payloads: DoD Mission - third space shuttle night launch. Additional Details: STS-33.
Second Magnum model ELINT satellite. Code name changed to Orion. Deployed from STS-33 November 23, 1989, and boosted to geostationary orbit.
Deployed from STS 32 1/10/89; 177 deg W; leased to U.S. government. The Leasat series was developed as a commercial venture to provide dedicated communications services to the U. S. military. Additional Details: Leasat 5.
Manned five crew. Deployed Leasat 5, retrieved LDEF. Night landing. Payloads: Deployment of Syncom IV-5, retrieval of Long Duration Exposure Facility (LDEF), Fluids Experiment Apparatus (FEA)-3, Protein Crystal Growth (PCG) III-2, Latitude/Longitude Locator (L3), American Flight Echocardiograph (AFE), Characterization of Neurospora Circadian Rhythms in Space (CNCR)-01, Air Force Maui Optical Site (AMOS)-4, Mesoscale Lightning Experiment (MLE), IMAX, Interim Operational Contamination Monitor (lOCM). Additional Details: STS-32.
Deployed from STS-36 2/28/90. Spent boosters, spent maneuvering stages, shrouds and other non-functional objects (US Cat D).
Manned five crew. Deployed a classified payload. Landed at: Runway 23 dry lake bed at Edwards Air Force Base, . Landing Speed: 368 kph. Touchdown miss distance: 494.00 m. Landing Rollout: 2,407.00 m. Payloads: DoD Mission - Record altitude (through 5/93). Additional Details: STS-36.
Deployed HST (Hubble Space Telescope). Payloads: Deployment of Hubble Space Telescope, IMAX camera in payload bay and in crew compartment, Protein Crystal Growth III-03, Investigation Into Polymer Membrane Process-ing- 01, Air Force Maui Optical Site-05, Radiation Monitoring Equipment III-01, Student Experiment 82-16, and Ascent Particle Monitor 01. Additional Details: STS-31.
Hubble Space Telescope; deployed from STS-31 4/25/90. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
![]() | Shuttle Landing Credit: NASA. 24,373 bytes. 474 x 298 pixels. |
Deployed from STS 41 10/6/90; solar research. Ulysses is a scientific spacecraft, within the framework of the international solar/polar mission. It will be the first spacecraft to fly over the poles of the sun. Frequency 2111.6073/2293.1481 MHz, 8408.2099 MHz., interplanetary trajectory i nto a polar flyby over the sun. Designator ESA/90/01. Also registered by the United States in ST/SG/SER.E/250, orbital data are taken from that document.
Manned five crew. Deployed a classified payload. Orbits of Earth: 79. Landed at: Runway 33 at Kennedy Space Center, Florida. Landing Speed: 359 kph. Touchdown miss distance: 430.00 m. Landing Rollout: 2,712.00 m. Payloads: DoD Mission. Additional Details: STS-38.
Deployed from STS 38 11/15/90. Boosted to geostationary orbit.
Manned seven crew. Carried ASTRO-1 observatory. Payloads: Ultraviolet Astronomy TeIescope (Astro), Broad-Band X-Ray Telescope (BBXRT), Shuttle Amateur Radio Experiment (SAREX), Air Force Maui Optical Site (AMOS). Additional Details: STS-35.
Astrophysical laboratory for gamma ray observations; deployed from STS-37 4/7/91; renamed Compton Gamma Ray Observatory. The Compton Gamma Ray Observatory was intentionally deorbited on by NASA over the objections of the scientific community on June 3, 2000. NASA decided to end the mission after several orientation gyroscope failures. They felt that if another gyroscope was lost, the heavy spacecraft might eventually reenter out of control.
Manned five crew. Unscheduled EVA to manually deploy the Gamma-Ray Observatory's high-gain antenna, which failed to deploy upon ground command. Payloads: Gamma-Ray Observatory (GRO), Crew/ Equipment Translation Aids (part of Extravehicular Activity Development Flight Experiment), Ascent Particle Monitor (APM), Bioserve Instrumentation Technology Associates Materials Dispersion Apparatus (BlMDA), Protein Crystal Growth (PCG)-Block Il, Space Station Heatpipe Advanced Radiator Element (SHARE)-ll, Shuttle Amateur Radio Experiment (SAREX)-ll, Radiation Monitoring Equipment (RME)-lIl, Air Force Maui Optical Site (AMOS) Calibration Test. Additional Details: STS-37.
Manned seven crew. Deployed USA 70, CRO A, CRO B, CRO C; deployed and retrieved IBSS. Payloads: Infrared Background Signature Survey (lBSS), Air Force Program (AFP)-675, Space Test Payload (STP)-I, Multi-Purpose Experiment Canister (MPEC), Cloud Logic to Optimize Use of Defense Systems (CLOUDS)-1A, Radiation Monitoring Equipment (RME)-lll. Additional Details: STS-39.
Chemical Release Observation; deployed 5/2/91; released gases for observation by IBSS. Spent boosters, spent maneuvering stages, shrouds and other non-functional objects (US Cat D).
Shuttle Pallet Satellite-II (SPAS-II) experiments were carried out on this classified mission. No details on whether SPAS was released or nature of experiments.
Chemical Release Observation; deployed 5/3/91; released gases for observation by IBSS. Spent boosters, spent maneuvering stages, shrouds and other non-functional objects (US Cat D).
Infrared Background Signature Survey; sensor technology test; retrieved 5/2/91. Spent boosters, spent maneuvering stages, shrouds and other non-functional objects (US Cat D).
Classified subsatellite released from shuttle.
Chemical Release Observation; deployed 5/2/91; released gases for observation by IBSS. Spent boosters, spent maneuvering stages, shrouds and other non-functional objects (US Cat D).
Carried Spacelab life sciences module. Payloads: Spacelab Life Sciences (SLS)-1 with long module, getaway special bridge assembly with 12 getaway specials, Physiological Monitoring System (PMS), Urine Monitoring System (UMS), Animal Enclosure Modules (AEM), Middeck Zero-gravity Dynamics Experiment (MODE), 7 Orbiter Experiments Program experiments. Additional Details: STS-40.
Manned five crew. Deployed TDRS 5 satellite. Payloads: Tracking and Data Relay Satellite (TDRS)-E/lnertial Upper Stage (lUS), Space Station Heatpipe Advanced Radiator Element (SHARE)-ll, Shuttle Solar Backscatter Ultraviolet (SSBUV) instrument 03, Optical Communications Through the Shuttle Window (OCTW), Air Force Maui Optical Site (AMOS) Calibration Test, Auroral Photography Experiment (APE)-B, Bioserve-lnstrumentation Technology Associates Materials Dispersion Apparatus (BlMDA)-02, Investigations Into Polymer Membrane Processing (IPMP)-03, Protein Crystal Growth Ill Block Il, Space Acceleration Measure-ment System (SAMS), Solid Surface Combustion Experiment (SSCE)-02, Tank Pressure Control Experiment (TPCE). Additional Details: STS-43.
NASA communications; 174 deg W; deployed from STS-43 8/2/91. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
Manned five crew. Deployed UARS; conducted materials and biological research. Payloads: Upper Atmosphere Research Satellite (UARS), Ascent Particle Monitor (APM)-03, Physiological and Anatomical Rodent Experiment (PARE)-01, Protein Crystal Growth (PCG)-ll-2, Middeck Zero-Gravity Dynamics, Experiment (MODE)-01, Investigations Into Polymer Membrane Processing (IPMP)-04, Cosmic Radiation Effects and Activation Monitor (CREAM-02), Radiation Monitoring Equipment (RME)-lll-06, Shuttle Activation Monitor (SAM)-03, Air Force Maui Optical Site (AMOS) Calibration Test. Additional Details: STS-48.
Upper Atmospheric Research Satellite; deployed from STS 48 9/15/91. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
Manned six crew. Deployed Defense Support Program satellite. Payloads: Defense Support Program satellite/ Inertial Upper Stage, Interim Operational Contamination Monitor, Terra Scout, Military Man in Space, Shuttle Activation Monitor, Cosmic Radiation Effects and Activation Monitor, Radiation Monitoring Equipment Ill, Air Force Maui Optical Site Calibration Test, Ultraviolet Plume Instrument, Visual Function Tester 1. Additional Details: STS-44.
Military early warning; deployed form STS 44 11/25/91.
Manned seven crew. Carried International Microgravity Laboratory-1. Payloads: International Microgravity Laboratory (lML)-1, getaway special (GAS) bridge with 10 getaway specials, IMAX camera, Gelation of Sols: Applied Microgravity Research (GOSAMR)-1, Investigations Into Polymer Mem-brane Processing (IPMP), Radiation Monitoring Equipment (RME)-lll, Student Experiment 81-09: Convection in Zero Gravity, Student Experiment 83-02: Capillary Rise of Liquid Through Granular Porous Media. Additional Details: STS-42.
Manned seven crew. Carried ATLAS-1 experimental package. Payloads: Atmospheric Laboratory for Applications and Science (ATLAS)-1, Shuttle Solar Backscat-ter Ultraviolet (SSBUV)-4, Getaway Special Experiment G-229, Space Tissue Loss (STL)-1, Radiation Monitoring Equipment (RME)-lIl, Visual Function Tester (VFT)-lI, Cloud Logic To Opti-mize Use of Defense Systems (CLOUDS)-1A, Investigations Into Polymer Membrane Process-ing (IPMP), Shuttle Amateur Radio Experiment (SAREX)-Il, Ultraviolet Plume Instrument (UVPl). Additional Details: STS-45.
Retrieved Intelsat 6 and attached new SRM. First active dual rendezvous of two orbiting spacecraft (Endeavour and Intelsat-Vl) First deployment of a drag chute on the orbiter fleet. Payloads: Intelsat-Vl reboost mission hardware, Assembly of Station by EVA Methods (ASEM), Commercial Protein Crystal Growth (CPCG), Air Force Maui Optical Site (AMOS) Calibration Test, Ultraviolet Plume Instrument (UVPl). Additional Details: STS-49.
Carried United States Microgravity Laboratory. First extended-duration mission. Payloads: United States Microgravity Laboratory (USML)-1; Orbital Acceleration Research Experiment (OARE); Investigations Into Polymer Membrane Processing (IPMP), Shuttle Amateur Radio Experiment (SAREX)-ll; Ultraviolet Plume Instrument (UVPl) . Additional Details: STS-50.
Manned seven crew. Deployed Eureca-1; failed to deploy Italian tether probe TSS-1. Payloads: Tethered Satellite System (TSS)-1; European Retrievable Carrier (EURECA)-1L; Evaluation of Oxygen Integration with Materials (EOlM)-lll/ Thermal Energy Management Processes (TEMP)-2A; Consortium for Materials Development In Space Complex Autonomous Payloads (CONCAP)-ll and Ill; IMAX Cargo Bay Camera (ICBC); Limited Duration Space Environment Candidate Materials Exposure (LDCE); Pituitary Growth Hormone Cell Function (PHCF); Ultravio-let Plume Instrument (UVPl). Additional Details: STS-46.
Microgravity experiments; deployed from STS-46 8/2/92; retrieved by STS-57; European Retrievable Carrier. EURECA is a European scientific and technology mission, launched by the US Space Transportation System. The spacecraft is scheduled to be retrieved likewise by the US/STS in late spring/early summer 1993. Designator ESA/92/01. Frequency plan: 2053.4583/22 30 MHz, 28 GHz/ 18 GHz (data-relay via Olympus).
Manned seven crew. Carried Spacelab-J with microgravity and biology experiments. Payloads: Spacelab-J, nine getaway special canister experiments, Israel Space Agency Investigation About Hornets (ISAIAH), Shuttle Amateur Radio Experiment (SAREX) II, Solid Surface Combus-tion Experiment (SSCE). Additional Details: STS-47.
Deployed Lageos 2, CTA. Payloads: Laser Geodynamic Satellite (LAGEOS) II/ Italian Research Interim Stage (IRIS), Canadian Experiments (CANEX) 2, United States Micro-gravity Payload (USMP) 1, Attitude Sensor Pack-age (ASP), Tank Pressure Control Experiment (TPCE), Physiological Systems Experiment (PSE), Heat Pipe Performance (HPP) experiment, Commercial Protein Crystal Growth (CPCG), Shuttle Plume Impingement Experiment (SPIE), Commercial Materials ITA Experiment (CMIX), Crystals by Vapor Transport Experiment (CVTE). Additional Details: STS-52.
Canadian Target Assembly; deployed from STS-52 10/22/92.
60 cm diameter sphere with laser reflectors; deployed from STS-52 10/23/92.
Manned five crew. Deployed classified military satellite USA 89. The ODERACS payload was unable to be deployed because of payload equipment malfunction. Payloads: Department of Defense (DOD)1; Glow Experiment/Cryogenic Heat Pipe Experiment Payload (GCP); Orbital Debris Radar Calibration System (ODERACS); Battlefield Laser Acquisition Sensor Test (BLAST); Cloud Logic To Optimize Use of Defense Systems (CLOUDS) 1A; Cosmic Radiation Effects and Activation Monitor (CREAM); Fluid Acquisition and Resupply Equipment (FARE); Hand-held, Earth-oriented, Real-time, Cooperative, User-friendly, Location-targeting and Environmental System (HER-CULES); Microencapsulation in Space (MIS)-1; Radiation Monitoring Equipment (RME) III; Spare Tissue Loss (STL); Visual Function Tester (VFT)2. Additional Details: STS-53.
![]() | Shuttle 2 views Credit: © Mark Wade. 13,544 bytes. 525 x 615 pixels. |
Deployed from STS-53 12/2/92.
NASA communications; deployed from STS-54 1/13/93. Spacecraft engaged in research and exploration of the upper atmosphere or outer space (US Cat B).
Manned five crew. Deployed TDRSS 6. Payloads: Tracking and Data Relay Satellite (TDRS)-F/Inertial Upper Stage (IUS); Diffuse X-ray Spectrometer (DXS); Chromosome and Plant Cell Division in Space (CHROMEX); Commercial Generic Bioprocessing Apparatus (CGBA) A; Physiological and Anatomical Rodent Experiment (PARE) 02; Solid Surface Combustion Experiment (SSCE). Additional Details: STS-54.
Studied solar corona and galaxy; deployed from STS-56 4/11/93; Shuttle Point Autonomous Research Tool for Astronomy; retrieved 4/13/93.
Manned five crew. Carried Atlas-2; deployed and retrieved Spartan 201. Payloads: Atmospheric Laboratory for Applications and Science (ATLAS) 2, Shuttle Solar Backscat-ter Ultraviolet (SSBUV) A, Shuttle Pointed Autonomous Research Tool for Astronomy (SPARTAN) 201 (Solar Wind Generation Experi-ment), Solar Ultraviolet Experiment (SUVE), Commercial Material Dispersion Apparatus (CMIX), Physiological and Anatomical Rodent Experiment (PARE), Hand-held, Earth-oriented, Real-time, Cooperative, User-friendly, Location-targeting, and Environmental System (HER-CULES), Shuttle Amateur Radio Experiment (SAREX) II, Space Tissue Loss (STL), Air Force Maui Optical Site (AMOS), Cosmic Radiation Effects and Activation Monitor (CREAM), Radiation Monitoring Equipment (RME) III. Additional Details: STS-56.
Manned seven crew. Carried German Spacelab-D2. Payloads: Spacelab D-2 with long module, unique support structure (USS), and Reaction Kinetics in Glass Melts (RKGM) getaway special, Shuttle Amateur Radio Experiment (SAREX) II. Additional Details: STS-55.
Manned six crew. Carried Spacehab 1; retrieved Eureca-1 spacecraft. Payloads: Spacehab 01, retrieval of European Retriev-able Carrier (EURECA) Satellite, Superfluid Helium On-Orbit Transfer (SHOOT), Consortium for Materials Development in Space Complex Autonomous Payload (CONCAP)-IV, Fluid Acquisition and Resupply Experiment (FARE), Shuttle Amateur Radio Experiment (SAREX) II, Air Force Maui Optical Site (AMOS), GAS bridge assembly with 12 getaway special payloads. Additional Details: STS-57.
Deployed and retrieved Orfeus-SPAS. During the EVA conducted tests in support of the Hubble Space Telescope first servicing mission and future EVAs, including Space Station assembly and maintenance. First night landing at KSC. Payloads: Advanced Communication Technology Sat-ellite (ACTS)/Transfer Orbit Stage (TOS), Orbiting Retrievable Far and Extreme Ultraviolet Spectrometer�Shuttle Pallet Satellite (ORFEUS-SPAS) with Remote IMAX Camera System (RICS), Limited Duration Space Environ-ment Candidate Materials Exposure (LDCE) (Beam Configuration C), Commercial Protein Crystal Growth (CPCG Block II), Chromosome and Plant Cell Division in Space (CHROMEX), High Resolution Shuttle Glow Spectroscopy-A (HRSGS-A), Auroral Photography Experiment-B (APE-B), Investigation into Polymer Membrane Processing (IPMP), Radiation Monitoring Equip-ment (RME-III), Air Force Maui Optical Site Cal-ibration Test (AMOS), IMAX In-Cabin Camera. Additional Details: STS-51.
Deployed from STS-51.
NASA experimental communications; Advanced Communications Technology Satellite; deployed from STS-51 9/12/93; 100 deg W.
Biological, microgravity experiments aboard Spacelab 2. Payloads: Spacelab Life Sciences (SLS) 2, Shuttle Amateur Radio Experiment (SAREX) II. Additional Details: STS-58.
Manned seven crew. Hubble repair mission. Conducted the most EVAs (5) on a Space Shuttle Flight to that date. Payloads: Hubble Space Telescope (HST) Servicing Mission (SM) 1, IMAX Camera, IMAX Cargo Bay Camera (ICBC), Air Force Maui Optical Site (AMOS). Additional Details: STS-61.
Orbital Debris Radar Calibration Sphere; deployed from STS-60.
Deployed ODERACS A-F, Bremsat, carried Wake Shield Facility. Payloads: Wake Shield Facility (WSF) 1 and SPACEHAB 02. Getaway special bridge assembly experiments: Capillary Pumped Loop (CAPL), Orbital Debris Radar Calibration Spheres (ODERACS), University of Bremen Satellite (BREMSAT), G-514, G-071, and G-536. Shuttle Amateur Radio Experiment (SAREX) II; Auroral Photography Experiment (APE-B). Additional Details: STS-60.
Orbital Debris Radar Calibration Sphere; deployed from STS-60. Space craft engaged in investigation of spaceflight techniques and technology (US Cat A).
Orbital Debris Radar Calibration Sphere; deployed from STS-60.
Atomic oxygen, dust particle, microgravity, reentry experiments.
Orbital Debris Radar Calibration Sphere; deployed from STS-60. Space craft engaged in investigation of spaceflight techniques and technology (US Cat A).
Orbital Debris Radar Calibration Sphere; deployed from STS-60. Space craft engaged in investigation of spaceflight techniques and technology (US Cat A).
Orbital Debris Radar Calibration Sphere; deployed from STS-60. Space craft engaged in investigation of spaceflight techniques and technology (US Cat A).
Carried USMP-2, OAST-2, SAMPIE, TES, EISG. Payloads: United States Microgravity Payload (USMP) 2, Office of Aeronautics and Space Technology (OAST) 2, Dexterous End Effector (DEE), Shuttle Solar Backscatter Ultraviolet/A (SSBUV/A), Limited-Duration Space Environment Candidate Material Exposure (LDCE), Advanced Protein Crystal Growth (APCG), Physiological Systems Experiment (PSE), Commercial Protein Crystal Growth (CPCG), Commercial Generic Bioprocessing Apparatus (CGBA), Auroral Photography Experiment Phase B (APE-B), Middeck Zero-Gravity Dynamics Experiment (MODE), Air Force Maui Optical Site (AMOS) Calibration Test, Bioreactor Demonstration System A. Additional Details: STS-62.
Carried SIR-C SAR radar. Payloads: Space Radar Laboratory (SRL) 1; Consortium for Materials Development in Space Com-plex Autonomous Payload (CONCAP) IV; three getaway special (GAS) payloads; Space Tissue Loss (STL) A, B; Visual Function Tester (VFT) 4; Shuttle Amateur Radio Experiment (SAREX) II. Additional Details: STS-59.
Carried IML-2; microgravity, biology experiments. Payloads: International Microgravity Laboratory (IML) 2, Orbital Acceleration Research Experiment (OARE), Commercial Protein Crystal Growth (CPCG), Air Force Maui Optical Site (AMOS), Military Applications of Ship Tracks (MAST), Shuttle Amateur Radio Experiment (SAREX). Additional Details: STS-65.
Payloads: Lidar In-Space Technology Experiment (LITE), Shuttle Pointed Autonomous Research Tool for Astronomy (SPARTAN) 201-II, Robot-Operated Materials Processing System (ROMPS), Shuttle Plume Impingement Flight Experiment (SPIFEX), getaway special (GAS) bridge assembly with ten GAS experiments, Trajectory Control Sensor (TCS), Simplified Aid for EVA Rescue (SAFER), Solid Surface Combustion Experiment (SSCE), Biological Research in Canisters (BRIC) III, Radiation Monitoring Experiment (RME) III, Military Applications of Ship Tracks (MAST), Shuttle Amateur Radio Experiment (SAREX) II, Air Force Maui Optical Site (AMOS) Calibration Test. Additional Details: STS-64.
Deployed from STS-64 9/13/94; retrieved 9/15/94; solar studies.
Carried SIR-C SAR. Landed at Edwards Air Force Base on October 11. Payloads: Space Radar Laboratory (SRL) 2, five Getaway Special payloads, Chromosome and Plant Cell Division in Space (CHROMEX) 5, Biological Research in Canisters (BRIC) 01, Cosmic Radiation Effects and Activation Monitor (CREAM), Military Application of Ship Tracks (MAST), Commercial Protein Crystal Growth (CPCG). Additional Details: STS-68.
Carried Atlas-3 laboratory; deployed and retrieved CRISTA-SPAS. Payloads: Atmospheric Laboratory for Applications and Science (ATLAS) 3, Cryogenic Infrared Spectrometers and Telescopes for the Atmo-sphere (CRISTA)-Shuttle Pallet Satellite (SPAS) 1, Experiment of the Sun for Complement-ing the ATLAS Payload for Education (ESCAPE) II, Inter-Mars Tissue Equivalent Proportional Counter (ITEPC), Shuttle Solar Backscatter Ultraviolet (SSBUV) A, Physiological and Anatomical Rodent Experiment (PARE/NIH-R), Protein Crystal Growth (PCG-TES and PCG-STES), Space Tissue Loss (STL/NIH-C-A), Shuttle Acceleration Measurement System (SAMS), Heat Pipe Performance (HPP). Additional Details: STS-66.
Released by STS-66 11/4/94; retrieved 11/12/95; atmospheric research.
Deployed ODERACS 2A-2E; deployed and retrieved Spartan 204. Discovery rendezvoused with Russia's space station, Mir, to a distance of 11 m and performed a fly-around, but did not dock with Mir. Payloads: SPACEHAB 03, Shuttle Pointed Autonomous Research Tool for Astronomy (SPARTAN) 204, Cryo Systems Experiment (CSE)/GLO-2 Experi-ment Payload (CGP)/Orbital Debris Radar Calibration Spheres (ODERACS) 2, Solid Surface Combustion Experiment (SSCE), Air Force Maui Optical Site (AMOS), IMAX Cargo Bay Camera (ICBC) Additional Details: STS-63.
Orbital Debris Radar Calibration spheres; deployed from STS 63 2/4/95.
Orbital Debris Radar Calibration spheres; deployed from STS 63 2/4/95. Reentered Sep 29
Orbital Debris Radar Calibration spheres; deployed from STS 63 2/4/95. Reentered?
Orbital Debris Radar Calibration spheres; deployed from STS 63 2/4/95. Reentered Mar 2
Retrievable payload to observe galactic dust in far UV; deployed from STS 63 2/7/95, retrieved 2/9/95.
Orbital Debris Radar Calibration spheres; deployed from STS 63 2/4/95. Reentered Feb 27
Reentered?
Carried Astro 2 astronomy payload with 3 UV telescopes.(attached to Endeavour).Payloads: Ultraviolet Astronomy (ASTRO) 2; Middeck Active Control Experiment (MACE); Protein Crystal Growth�Thermal Enclosure System (PCG-TES) 03; Protein Crystal Growth�Single-Locker Thermal Enclosure System (PCG-STES) 02; Commercial Materials Dispersion Apparatus Minilab/Instrumentation Technology Associates, Inc. Experiments (CMIX) 03; Shuttle Amateur Radio Experiment (SAREX) II; two getaway special experiments. Additional Details: STS-67.
Mir Expedition EO-19. Transferred Budarin, Solovyov to Mir, returned Soyuz TM-21 crew to Earth. After undocking from Mir on July 4, Atlantis spent several days on orbit, carrying out medical research work with the Spacelab-Mir module in the cargo bay. Payloads: Shuttle/Mir Mission 1, Spacelab-Mir, IMAX camera, Shuttle Amateur Radio Experiment (SAREX). Additional Details: STS-71.
Deployed TDRS 7. Payloads: Tracking and Data Relay Satellite (TDRS) G/ Inertial Upper Stage (IUS); Bioreactor Demon-stration System (BDS) B; Biological Research in Canisters (BRIC); Commercial Protein Crystal Growth (CPCG); Hand-Held, Earth-Oriented, Real-Time, Cooperative, User-Friendly, Location-Targeting and Environmental System (HER-CULES); Microcapsules in Space (MIS) B; Physiological and Anatomical Rodent Experiment (PARE)/National Institutes of Health (NIH) Rodents (R); Radiation Monitoring Experiment (RME) III; Shuttle Amateur Radio Experiment (SAREX) II; Space Tissue Loss (STL)/National Institutes of Health (NIH) Cells (C); Military Applications of Ship Tracks (MAST); Visual Function Tester (VFT) 4; Window Experiment (WINDEX). Additional Details: STS-70.
NASA communications; deployed from STS-70 on 7/13/95. Stationed at 149.8 deg W.
Deployed and retrieved Spartan 201, WSF 2. Payloads: Wake Shield Facility (WSF) 2; Shuttle Pointed Autonomous Research Tool for As-tronomy (SPARTAN) 201; International Extreme Ultraviolet Hitchhiker (IEH)1; Inter-Mars Tissue Equivalent Proportional Counter (ITEPC); Extravehicular Activity Development Flight Test (EDFT) 2; Capillary Pumped Loop (CAPL) 2/ getaway special (GAS) bridge assembly with five GAS payloads; Auroral Photography Experiment (APE) B; Biological Research in Canisters (BRIC); Commercial Generic Bioprocessing Apparatus (CGBA), Configuration A; Electrolysis Perfor-mance Improvement Concept Study (EPICS); Space Tissue Loss (STL)/National Institutes of Health (NIH) Cells (C); Commercial Middeck Instrumentation Technology Associates Experiment (CMIX). Additional Details: STS-69.
Released by STS-69 9/8/95; retrieved 9/10/95; examined solar corona.
Wake Shield Facility; released by STS-69 9/11/95; retrieved 9/14/95; semiconductor materials research. Retrieved by Endeavour Sep 14
Carried USML-2 for microgravity experiments (attached to Columbia). Payloads: United States Microgravity Laboratory (USML) 2, Orbital Acceleration Research Experiment (OARE). Additional Details: STS-73.
Atlantis rendezvoused and docked with Mir space station on Nov 15. After departure the Russian-built 316GK Shuttle-Mir docking module remained attached to Mir to provide easier docking capability in the future.
Rendezvoused and docked with Mir space station on November 15. Delivered the Russian-built 316GK Shuttle-Mir docking module to Mir.Payloads: Shuttle-Mir Mission 2; docking module with two attached solar arrays; IMAX Cargo Bay Camera (ICBC); Glow Experiment (GLO-4)/ Photogrammetric Appendage Structural Dynamics Experiment (PASDE) Payload (GPP); Shuttle Amateur Radio Experiment (SAREX) II. Additional Details: STS-74.
GPS receiver, amateur radio tests; examined effect of solar radiation on satellite explosive devices; deployed from STS 72 1/14/96; retrieved 1/16/96.
Deployed and retrieved OAST Flyer; retrieved SFU Space Flyer Unit. Beside the two satellite retrievals, the mission included two spacewalks. Additional Details: STS-72.
LEO. Tether deployment test; 20 km long tether; satellite unintentionally deployed when tether broke 2/25/96 Reentered Mar 19.
Carried TSS-1R tether satellite; satellite tether broke during deployment, making TSS-1R an unintentional free flyer
Payloads: Tethered Satellite System (TSS) Reflight (1R); Orbital Acceleration Research Experiment (OARE) (part of United States Microgravity Payload 3); USMP-3; Commercial Protein Crystal Growth (CPCG) 09, Block IV; Middeck Glovebox Experiment (MGBX) (part of USMP-3). During the deployment of TSS, the tether broke and the satellite was lost. Additional Details: STS-75.
Shuttle-Mir Mission 3. Docked with the Mir space station 24 March 1996; Shannon Lucid was left on Mir for an extended stay. First American EVA on Mir. Payloads: SPACEHAB/Mir 03; KidSat; Shuttle Amateur Radio Experiment (SAREX) II, Configuration M; RME 1304�Mir/ Environmental Effects Payload (MEEP); orbiter docking system RME 1315; Trapped Ions in Space Experiment (TRIS); Extravehicular Activity Development Flight Test (EDFT) 04. Additional Details: STS-76.
LEO. Passive Aerodynamically Stabilized Magnetically Damped Satellite; deployed from STS 77 5/22/96; attitude control technology test. Reentered Oct 26.
Deployed and retrieved Spartan 2; deployed PAMS-STU; carried Spacehab module. Payloads: Shuttle Pointed Research Tool for Astronomy (SPARTAN) 207/Inflatable Antenna Experiment (IAE); Technology Experiments Advancing Missions in Space (TEAMS) 01 (includes Vented Tank Resupply Experiment (VTRE), Global Positioning System (GPS) Attitude and Navigation Experiment (GANE) (RME 1316), Liquid Metal Test Experiment (LMTE) and Passive Aerodynami-cally Stabilized Magnetically Damped Satellite (PAMS) Satellite Test Unit (STU); SPACEHAB-4; Brilliant Eyes Ten-Kelvin Sorption Cryocooler Experiment (BETSCE); 12 getaway specials attached to a GAS bridge assembly (GAS 056, 063, 142, 144, 163, 200, 490, 564, 565, 703, 741 and the Reduced-Fill Tank Pressure Control Experiment (RFTPCE); Aquatic Research Facility (ARF) 01; Biological Research in Canisters (BRIC) 07, Block III. Additional Details: STS-77.
LEO. Deployed from STS 77 on 5/20/96; retrieved 5/21/96; deployed IAEsatellite during free flight.
LEO. Inflatable Antenna Experiment; deployed from Spartan 207 5/20/96; test of inflatable antenna technology. Reentered May 22.
LEO. Columbia; carried Terence T. Henricks, Kevin R. Kregel, Susan J. Helms, Richard M. Linnehan, Charles E. Brady, Jr., Jean-Jacques Favier, Robert Brent Thirsk; carried Life and Microgravity Spacelab; human biological and microgravity experiments. Landed aboard STS-78.
Carried Life and Microgravity Spacelab; human biological and microgravity experiments. Landed KSC July 7. Additional Details: STS-78.
On September 19 Atlantis docked with the Russian Mir space station. Aboard Atlantis in the payload bay were the Orbiter Docking System, the modified Long Tunnel, and the Spacehab Double Module, containing supplies for the Mir. Astronaut John Blaha relieved Shannon Lucid as NASA resident on the complex. Atlantis undocked from the Mir complex on September 23 at 23:33 GMT. Valeriy Korzun, Aleksandr Kaleri and John Blaha remain on Mir. On September 26 Atlantis closed its payload bay doors, and at 11:06 GMT fired its OMS engines for a three minute long deorbit burn. After entry interface at 11:42 GMT the spaceship flew across Canada and the US for a landing at the Kennedy Space Center's Runway 15 at 12:13 GMT. Additional Details: STS-79.
Remained attached to OV-104
Retrieved Nov 26
Mission STS-80 carried the Orfeus astronomy satellite, the Wake Shield Facility, and spacewalk equipment. The Orfeus satellite was deployed on November 20. It carried an ultraviolet telescope and spectrographs. Wake Shield Facility was deployed on November 22 and retrieved on November 26 . On 1996 Nov 29, crewmembers Tamara Jernigan and Thomas Jones were to conduct the first of several planned EVAs. However the shuttle's exit hatch would not open and NASA cancelled this and the other planned spacewalks of the mission. On December 4 at the astronauts retrieved the Orfeus satellite using the RMS arm. Reentry attempts on Dec 5 and Dec 6 were called off due to bad weather. Columbia finally landed at 11:49 GMT December 7 on Runway 33 at Kennedy Space Center, making STS-80 the longest shuttle mission to that date . Additional Details: STS-80.
Retrieved Dec 4
After a night launch of Space Shuttle Atlantis, the Shuttle docked with Mir at 03:55 GMT on January 14. STS-81 transferred 2,715 kg of equipment to and from the Mir, the largest transfer of items to that date. During the docked phase, 640 kg of water, 515 kg of U.S. science equipment, 1,000 kg of Russian logistics, and 120 kg of miscellaneous material were transferred to Mir. Returned to Earth aboard Atlantis were 570 kg of U.S. science material, 405 kg of Russian logistics and 98 kg of miscellaneous material. At 02:16 GMT January 19, Atlantis separated from Mir after picking up John Blaha, who had arrived aboard STS-79 on September 19, 1996, and dropping off Jerry Linenger, who was to stay aboard Mir for over four months. The Shuttle backed off along the -RBAR (i.e. toward the Earth) to a distance of 140 m before beginning a flyaround at 02:31 GMT. Most of the flyaround was at a distance from Mir of 170 m. The first 'orbit' around Mir was complete at 03:15, and the second was completed at 04:02 GMT. Then the Orbiter fired its jets to drift away from the orbit of Mir. NASA's first Shuttle mission of 1997 came to a close with a landing at the Kennedy Space Center at 14:22 GMT on January 22 (after the first opportunity was waved off due to cloud cover at the Cape). Additional Details: STS-81.
After a spectacular night launch, the Shuttle completed its rendezvous with Hubble Space Telescope on February 13. Over the next four days five spacewalks were undertaken to renovate Hubble.
The Hubble Space Telescope was released back into orbit at 06:41 GMT on February 19. Discovery landed on Runway 15 at Kennedy Space Center at 08:32 GMT on February 21. Additional Details: STS-82.
The launch of STS-83, the first Microgravity Science Laboratory (MSL-1) mission, was postponed for a day to replace some insulation around a water coolant line in Columbia's payload bay. Liftoff was further delayed 20 minutes due to anomalous oxygen readings in the orbiter's payload bay. STS-83 was cut short due to a problem with one of the three fuel cells that provide electricity and water to Columbia (flight rules required that all three must be operating). At 14:30 GMT on April 6 the crew were ordered to begin a Minimum Duration Flight (MDF). On April 8 the OMS engines ignited at 17:30 GMT for the deorbit burn, and Columbia landed on Runway 33 at Kennedy Space Center at 18:33 GMT.
With delays in International Space Station construction leaving ample room in the shuttle schedule, NASA made the unique decision to leave the equipment installed in Columbia and refly this mission with the same crew later in 1997 as STS-94. Additional Details: STS-83.
Remained attached to OV-102
Atlantis blasted off on a night launch to Mir, docking with the station on May 17 at 02:33 GMT. Jerry Linenger, who had begun his stay on Mir in mid-January aboard STS-81, would return aboard STS-84. Michael Foale would be left at the station for his stint as the American crew member of Mir. The crew transfered to Mir 466 kg of water, 383 kg of U.S. science equipment, 1,251 kg of Russian equipment and supplies, and 178 kg of miscellaneous material. Returned to Earth aboard Atlantis were 406 kg of U.S. science material, 531 kg of Russian logistics material, 14 kg of ESA material and 171 kg of miscellaneous material. Atlantis undocked from Mir at 01:04 GMT on May 22. After passing up its first landing opportunity due to clouds over the landing site, the Shuttle fired its OMS engines on the deorbit burn at 12:33 GMT on May 24. Atlantis landed at 13:27 GMT at Kennedy Space Center's runway 33. Additional Details: STS-84.
Remained attached to OV-102
STS-94 was the reflight, with the same equipment and crew, of the curtailed STS-83 mission. Cargo Bay Payloads:
In-Cabin Payloads: SAREX, MSX
The mission this time went for its full two week duration and the crew completed the full list of experiments. The deorbit burn was on July 17, 1997 at 09:44 GMT and Columbia landed on KSC's Runway 33 at 10:46:34 GMT. Additional Details: STS-94.
Deployed and retrieved the CRISTA-SPAS-2 (the Cryogenic Infrared Spectrometers and Telescopes for the Atmosphere-Shuttle Pallet Satellite-2) designed to study Earth's middle atmosphere. The CRISTA-SPAS-2 was making its second flight on the Space Shuttle and represented the fourth mission in a cooperative venture between the German Space Agency (DARA) and NASA.
CRISTA-SPAS was deployed by the RMS arm at 22:27 GMT on August 7 and was recaptured by Discovery's RMS arm at 15:14 GMT on August 16. Because of unfavorable weather conditions at the primary shuttle landing site at the Kennedy Space Center, Discovery was waved off for its scheduled August 18 landing. STS-85 landed the next day, at Kennedy Space Center at 11:08 GMT. Additional Details: STS-85.
Recaptured August 16.
Atlantis was launched on a mission to the Russian Mir space station. The TI rendevous terminal initiation burn was carried out at 17:32 GMT on September 27, and Atlantis docked with the SO (Docking Module) on the Mir complex at 19:58 GMT. The crew exchange was completed on September 28, with David Wolf replacing Michael Foale on the Mir crew. On October 1 cosmonaut Titov and astronaut Parazynski conducted a spacewalk from the Shuttle payload bay while Atlantis was docked to Mir. They retrieved four MEEP (Mir Environmental Effects Payload ) exposure packages from Mir's SO module and installed the Spektr solar array cap. The MEEP experiments had been attached to the Docking Module by astronauts Linda Godwin and Rich Clifford during Shuttle mission STS-76 in March 1996. In addition to retrieving the MEEP, Parazynski and Titov were to continue an evaluation of the Simplified Aid For EVA Rescue (SAFER), a small jet-backpack designed for use as a type of life jacket during station assembly.
Atlantis undocked from Mir at 17:28 GMT on October 3 and conducted a flyaround focused on the damaged Spektr Module to determine the location of the puncture in its hull. The Mir crew pumped air into the Spektr Module using a pressure regulator valve, and the Shuttle crew observed evidence that, as expected, the leak seemed to be located at the base of the damaged solar panel. Final separation of Atlantis from Mir took place around 20:28 GMT. After two landing attempts were waved off on October 5 due to heavy cloud cover, the crew fired the engines to deorbit at 20:47 GMT on October 6 and landed at Kennedy Space Center at 21:55. Additional Details: STS-86.
Remained attached to OV-104
Retrieved by OV-102 Nov 25
Retrieved by OV-102 Dec 3.
OV-102 Columbia was launched on a microgravity science mission. Spartan 201 was released a day late on November 21. However the satellite did not start its automatic orientation maneuver because the crew failed to send it the correct commands prior to release.
Spartan was recaptured by hand, during a spacewalk by Takao Doi and Winston Scott on November 25. Tests of space station tools went well, but the free-flying Sprint camera subsatellite was not deployed due to lack of time.
NASA decided not to redeploy Spartan on this mission. During an EVA on Dec 3, Doi and Scott carried out more tests of the Space Station crane. They also deployed the AERCam/Sprint 'football' remote-controlled camera for a free flight in the payload bay.
Columbia landed on December 5, with a deorbit burn at 11:21 GMT. Touchdown was at 12:20 GMT at Kennedy Space Center. Additional Details: STS-87.
Penultimate Shuttle mission to Mir. Andy Thomas replaced David Wolf as the resident NASA astronaut. Endeavour docked with the SO module on Mir at 20:14 GMT on January 24, 1998.
Payloads included:
Despite fits problems with his Sokol emergency spacesuit, Andy Thomas replaced David Wolf as a Mir crew member on January 25. Endeavour undocked from Mir on January 29 at 16:57 GMT and made one flyaround of the station before departing and landing at Kennedy Space Center's runway 15 at 22:35 GMT on January 31.
Columbia rolled out to pad 39B on March 23. Payloads:
The Neurolab mission was managed by NASA-Johnson at Houston, unlike earlier Spacelab flights which were NASA-Marshall/Huntsville's responsibility. Landed at Kennedy Space Center May 3 1998.
The final shuttle-Mir mission, STS-91 recovered NASA astronaut Andy Thomas from the Mir station and took Russian space chief and ex-cosmonaut Valeri Ryumin to Mir for an inspection tour of the ageing station. This was the first test of the super lightweight Aluminium-Lithium alloy external tank, designed to increase shuttle payload to the Mir / International Space Station orbit by 4,000 kg. At 22:15 GMT Discovery entered an initial 74 x 324 km x 51.6 deg orbit, with the OMS-2 burn three quarters of an hour later circulising the chase orbit. Discovery docked with the SO module on Mir at 17:00 GMT on June 4. NASA equipment was retrieved from the station, and Discovery undocked at 16:01 GMT on June 8, and landed on Runway 15 at Kennedy Space Center at 18:00 GMT on June 12.
First attempted launch of STS-88 was scrubbed at 09:03 GMT on December 3 due to a problem with a hydraulic system sensor. Launch came the next day, with Endeavour entering an initial 75 km x 313 km x 51.6 degree orbit. Half an orbit after launch, at 09:19 GMT, Endeavour fired its OMS engines to raise the orbit to 180 km x 322 km x 51.6 degree.
On December 5 at 22:25 GMT Nancy Currie unberthed the Unity space station node from the payload bay using the RMS arm. She then moved the Unity to a position docked to the Orbiter Docking System in the payload bay in readiness for assembly with the Russian-launched Zarya FGB ISS component. After rendezvous with the Zarya FGB module, on December 6 at 23:47 GMT Endeavour grappled Zarya with the robot arm, and at 02:07 GMT on December 7 it was soft docked to the PMA-1 port on Unity. After some problems hard dock was achieved at 02:48 GMT. Unity and Zarya then formed the core of the future International Space Station. Ross and Newman made three space walks to connect cables between Zarya and Unity, on December 7, 9 and 12. On the last EVA a canvas tool bag was attached to the exterior of Unity to provide tools for future station assembly workers. Docking cables were disconnected to prevent Unity and Zarya from inadvertently undocking. Following an internal examination of the embryonic space station, Endeavour undocked at 20:30 GMT on December 13. The SAC-A and Mightysat satellites were ejected from the payload bay on December 14 and 15. Deorbit burn was December 16 at 03:48 GMT, and Endeavour landed at 04:53:29 GMT, on Runway 15 at the Kennedy Space Center.
Payloads included:
First flight of a USAF Philips Laboratory/Space Experiments Directorate ejectable technology demonstration platform. Four advanced technologies demonstrated, including composite structure, advanced solar cells, advanced electronics, and a shock device.
SAC-A was to provide engineering bench testing for new space science technology instruments and equipment that will be used in a more complex spacecraft for the Argentine space program.
Retrieved by Discovery November 3 1998.
The flight of STS-95 provoked more publicity for NASA than any other flight in years, due to the presence of ex-astronaut Senator John Glenn on the crew, which also included the first Spanish astronaut, Pedro Duque. The US Navy PANSAT student satellite was deployed on Oct 30 into a 550 km x 561 x 28.5 degree orbit. The Spartan 201 satellite was deployed from Discovery on November 1 and retrieved on November 3. Spartan 201 was on its fifth mission to observe the solar corona. The data on this mission would be used to recalibrate the SOHO satellite which recently resumed observation of the Sun following loss of control. Discovery landed at 17:03:31 GMT November 7 on Runway 33 at the Shuttle Landing Facility at Kennedy Space Center. Additional Details: STS-95.
Discovery docked at the PMA-2 end of the International Space Station PMA-2/Unity/PMA-1/Zarya stack. The crew transferred equipment from the Spacehab Logistics Double Module in the payload bay to the interior of the station. Tammy Jernigan and Dan Barry made a space walk to transfer equipment from the payload bay to the exterior of the station. The ODS/EAL docking/airlock truss carried two TSA (Tool Stowage Assembly) packets with space walk tools. The Integrated Cargo Carrier (ICC), built by Energia and DASA-Bremen, carried parts of the Strela crane and the US OTD crane as well as the SHOSS box which contains three bags of tools and equipment to be stored on ISS's exterior.
The STS-96 payload bay manifest:
On May 30 at 02:56 GMT Tammy Jernigan and Dan Barry entered the payload bay of Discovery from the tunnel adapter hatch, and made a 7 hr 55 min space walk, transferring equipment to the exterior of the station.
On May 31 at 01:15 GMT the hatch to Unity was opened and the crew began several days of cargo transfers to the station. Battery units and communications equipment were replaced and sound insulation was added to Zarya. Discovery undocked from ISS at 22:39 GMT on June 3 into a 385 x 399 km x 51.6 degree orbit, leaving the station without a crew aboard. On June 5 the Starshine satellite was ejected from the payload bay. The payload bay doors were closed at around 02:15 GMT on June 6 and the deorbit burn was at 04:54 GMT. Discovery landed on runway 15 at Kennedy Space Center at 06:02 GMT. Additional Details: STS-96.
At 0:721 GMT on June 5 the Starshine satellite was ejected into a 379 x 396 km x 51.6 degree orbit from a canister at the rear of STS-96 Space Shuttle Discovery's payload bay. The small Starshine satellite, built by NRL, was to be observed by students as part of an educational exercise.
STS-93 was first rolled out to pad 39B on June 7 1999. The Chandra/IUS-27 vehicle was placed in the payload canister on June 19. The first launch attempt was on July 20, but controllers aborted the launch at T-6 seconds, just before main engine ignition, due to a data spike in hydrogen pressure data. This was determined to be due to a faulty sensor and a second attempt was on July 22. A lightning storm prevented launch during the 46 minute window, and the launch was again scrubbed. Finally the vehicle lifted off the pad on July 23, but five seconds after launch a short in an electrical bus brought down two of the three main engine controllers. Backup controllers took over, but a further failure on the backup controller bus would have resulted in engine shutdown and the first ever attempt at an RTLS (Return To Launch Site) abort. To further complicate matters engine 3 (SSME 2019) had a hydrogen leak throughout the ascent, causing the engine to run hot. Controllers sweated as temperatures neared redline. The hot engine�s controller compensated as programmed by using additional liquid oxygen propellant. The final result was that the shuttle ran out of gas - main engine cut-off (MECO) was at 04:39 GMT, putting Columbia into a 78 km x 276 km x 28.5 degree transfer orbit. Columbia was 1,700 kg short of oxygen propellant and 5 meters/sec slower than planned. The OMS-2 engine burn at 05:12 GMT circularised the orbit 10 km lower than planned.
The orbiter payload bay contained only the Chandra spacecraft, the IUS, and the IUS tilt tableTthe following payloads were carried in the shuttle�s cabin: STL-B (Space Tissue Loss), CCM (Cell culture module), SAREX-II (Shuttle Amateur Radio Experiment), EarthKam, PGIM (Plant Growth Investigations in Microgravity), CGBA (Commercial Generic Bioprocessing Apparatus), MEMS (Micro-electric Mechanical System), and BRIC (Biological Research in Canisters) and SWUIS (the Southwest Ultraviolet Imaging System, an 0.18-m UV telescope to be used for airglow and planetary observations); GOSAMR (the Gelation of Sols: Applied Microgravity Research experiment) and LFSAH, the Lightweight Flexible Solar Array Hinge. MSX and SIMPLEX experiments were also to be carried out.
Chandra/IUS-27 was deployed from Columbia at 11:47 GMT July 23. Flight duration was limited; this was the heaviest shuttle (122,534 kg) and heaviest payload (19,736 kg) to that date. Columbia landed at 03:20 GMT on July 28 on runway 33 at Kennedy Space Center. Post-flight inspection found the presence of holes in the cooling lines on the nozzle of SSME 2019 (engine 3) which caused a hydrogen leak. A loose repair pin in the engine broke free and caused the failure. The cause of the short was found to be chaffed wiring inside the shuttle. The entire fleet was grounded for inspection and replacement of wiring as necessary.
The Chandra Advanced X-ray Astrophysics Facility was one of NASA�s four Great Observatories (along with Hubble Space Telescope, Compton Gamma Ray Observatory, and the SIRTF). Chandra will study the composition and nature of galaxies, stellar objects and interstellar phenomena as well as basic issues in theoretical physics using the most sensitive X-ray telescope ever built. The IUS under-performed and placed Chandra in an orbit about 900 km lower than planned. Therefore Chandra's own IPS propulsion system had to be used to make up the difference. The first such manoeuvre was at 01:11 GMT on July 25 when the IPS engines fired for 5 minutes to raise perigee to 1192 km. Further perigee burns on July 31, August 4, and August 7 raised the orbit to its final 10,000 km x 140.000 km. Additional Details: Chandra.
Hubble Space Telescope (HST) servicing mission SM-3A, delayed repeatedly by technical problems with the shuttle fleet after the near-disastrous previous launch. Finally launched after the last possible day to avoid Y2K computer problems; one spacewalk was cancelled so that the shuttle could return by December 28. Hubble was in a 591 km x 610 km x 28.5 deg orbit at launch. After separation of the external tank ET-101 the Orbiter was in a 56 km x 587 km x 28.5 deg transfer orbit. The OMS 2 burn at 0134 UTC raised the orbit to 313 km x 582 km. The payload bay contained:
On an extremely successful mission the space shuttle Endeavour deployed the 61 metre long STRM mast. This was a side-looking radar that digitally mapped with unprecedented accuracy the entire land surface of the Earth between latitudes 60 deg N and 54 deg S. Sponsors of the flight included the US National Imagery and Mapping Agency (NIMA), NASA, and the German and Italian space agencies. Some of the NIMA data would remain classified for exclusive use by the US Department of Defense. Additional Details: STS-99.
Objective of mission STS-101 was repair, resupply and construction tasks aboard the international space station. This was the first launch with new electronic cockpit displays and other upgrades. The solid boosters separated at 10:13 GMT and the main engines cutoff at 10:19 GMT. The external tank, ET-102 then separated, with both orbiter and ET-102 in a 52 x 320 km initial orbit. At 10:54 GMT the OMS engines fired to raise perigee to 159 x 329 km x at 51.6 deg. Atlantis docked with the International Space Station's PMA-2 docking adapter on the Unity node at 04:31 GMT on May 21. At that time the ISS was in a 332 x 341 km orbit.
On May 22 mission specialists Jeff Williams and James carried out external maintenance work on the ISS.
On May 23 at 00:03 GMT the Atlantis crew opened the first hatch to PMA-2 and entered the Station. The crew replaced a set of batteries in Zarya, installed fans and ducting to improve airflow, and delivered supplies and equipment. Three hour-long orbit raising burns on May 24 and 25 by the RCS engines on Atlantis raised the station to a 372 x 380 km x 51.6 deg orbit.
The STS-101 crew left the station on May 26, closing the PMA-2 hatch at 08:08 GMT and undocking at 23:03 GMT. Atlantis performed a 180 degree flyaround of the station and departed the vicinity around 23:44 GMT.
Atlantis closed its payload bay doors around 02:30 GMT on May 29 and fired the OMS engines for deorbit at 05:12 GMT. The vehicle landed on RW15 at Kennedy Space Center at 06:20 GMT. Atlantis was to be turned around for the next ISS shuttle flight, STS-106.
Left in orbit was the renovated International Space Station, equipped with an upgraded electrical system, new fans, filters, fire extinguishers, smoke detectors and communications gear. Additional Details: STS-101.
Atlantis was launched from Kennedy Space Center's Launch Complex 39B. Solid rocket boosters RSRM-75 and external tank ET-103 were used to loft the orbiter into space. The inital orbit of 72 x 328 km x 51.6 deg was circularised by the Shuttle's OMS engines at apogee.
Atlantis docked with the PMA-2 adapter on the International Space Station at 05:51 GMT on September 10. The orbiter's small RCS engines were used to gently reboost the station's orbit several times.
Astronauts Lu and Malenchenko made a spacewalk on September 11 beginning at 04:47 GMT. They rode the RMS arm up to Zvezda and began installing cables, reaching a distance of 30 meters from the airlock when installing Zvezda's magnetometer. Total EVA duration was 6 hours 21 minutes.
During their 12-day flight, the astronauts spent a week docked to the International Space Station during which they worked as movers, cleaners, plumbers, electricians and cable installers. In all, they spent 7 days, 21 hours and 54 minutes docked to the International Space Station, outfitting the new Zvezda module for the arrival of the Expedition One crew later this fall.
The Shuttle undocked from ISS at 03:44 GMT on September 18 and made two circuits of the station each lasting half an orbit, before separating finally at 05:34 GMT. The payload bay doors were closed at 04:14 GMT on September 20 and at 06:50 GMT the OMS engines ignited for a three minute burn lowering the orbit from 374 x 386 km x 51.6 deg to 22 x 380 km x 51.6 deg. After entry interface at 07:25 GMT, the orbiter glided to a landing on runway 15 at Kennedy Space Center with main gear touchdown at 07:56:48 GMT for a mission duration of 283 hr 11min. Additional Details: STS-106.
STS-92 was a space station assembly flight to bring the Z-1 Truss (mounted on a Spacelab pallet), Control Moment Gyros, Pressurised Mating Adapter-3 (PMA-3) and two DDCU (Heat pipes) to the International Space Station.
The RSRM-76 solid rocket boosters separated at 23:19 GMT and main engine cut-off (MECO) came at 23:25 GMT. External tank ET-104 separated into a 74 x 323 km x 51.6 deg orbit. At apogee at 00:01 GMT on Oct 12, Discovery's OMS engines fired to raise perigee to a 158 x 322 km x 51.6 deg orbit; ET-104 re-entered over the Pacific around 00:30 GMT. At Oct 12 on 03:01 GMT the NC1 burn raised the orbit to 180 x 349 km; NC3 on Oct 12 to 311 x 375 km; and the TI burn at 14:09 GMT on Oct 13 to 375 x 381 km x 51.6 deg. Discovery's rendezvous with the International Space Station came at 15:39 GMT on Oct 13, with docking at 17:45 GMT. The spaceship docked with PMA-2, the docking port on the +Y port of the Space Station's Unity module. Hatch was open to PMA-2 at 20:30 GMT the same day.
STS-92 Cargo Manifest
Total payload bay cargo: ca. 14,800 kg
The Z1 first segment of the space station truss was built by Boeing/Canoga Park and was 3.5 x 4.5 meters in size. It was attached to the +Z port on Unity. Z1 carried the control moment gyros, the S-band antenna, and the Ku-band antenna.
PMA-3, built by Boeing/Huntington Beach, was docked to the -Z port opposite Z1. PMA-3 was installed on a Spacelab pallet for launch.
On October 14 at 16:15 GMT the Z1 segment was unberthed from the payload bay and at around 18:20 GMT it was docked to the zenith port on the Unity module.
On October 15 at 14:20 GMT the ODS airlock was depressurised, beginning a spacewalk by Bill McArthur and Leroy Chiao. Official NASA EVA duration (battery power to repress) was 6 hours 28 minutes.
The second spacewalk was on October 16, with Jeff Wisoff and Mike Lopez-Alegria. The suits went to battery power at 14:15 GMT and Wisoff left the airlock at 14:21 GMT. Repressurisation began at 21:22 GMT for a duration of 7 hours 07minutes.
Leroy Chiao and Bill McArthur began the third STS-92 EVA at 15:30 GMT on October 17, completing their work at 22:18 GMT for a total time of 6 hours 48 minutes.
After the spacewalk, Discovery completed the second of the three station reboosts scheduled for STS-92. They fired reaction control system jets in a series of pulses of 1.4 seconds each, over a 30-minute period, gently raising the station's orbit by about 3.1 km.
The last of four successful spacewalks began on 18 October at 16:00 GMT and ended at 22:56 GMT, lasting 6 hours and 56 minutes. Jeff Wisoff and Mike Lopez-Alegria each jetted slowly through space above Discovery's cargo bay.
After the space walk, Discovery completed the third and final reboost of the space station.
On 19 October the astronauts worked within the ISS. They completed connections for the newly installed Z1 external framework structure and transferred equipment and supplies for the Expedition One first resident crew of the Station. The crew also tested the four 290-kg gyroscopes in the truss, called Control Moment Gyros, which will be used to orient the ISS as it orbits the Earth. They will ultimately assume attitude control of the ISS following the arrival of the U.S. Laboratory Destiny. The tests and the transfer of supplies into the Russian Zarya Module took longer than expected. As a result, the crew's final departure from the Station's Unity module was delayed. Melroy and Wisoff took samples from surfaces in Zarya to study the module's environment. They then unclogged the solid waste disposal system in the Shuttle's toilet, which was restored to full operation after a brief interruption in service.
Discovery undocked from the ISS at 16:08 GMT on 20 October. The final separation burn was executed about 45 minutes after undocking. The crew had added 9 tonnes to the station's mass, bringing it to about 72 tonnes. The return to earth, planned for 22 October, was delayed repeatedly due to high winds at the Kennedy landing site. The landing was finally made at Edwards Air Force Base, California, on October 24, at 22:00 GMT. Additional Details: STS-92.
