astronautix.com | Energia |
![]() |

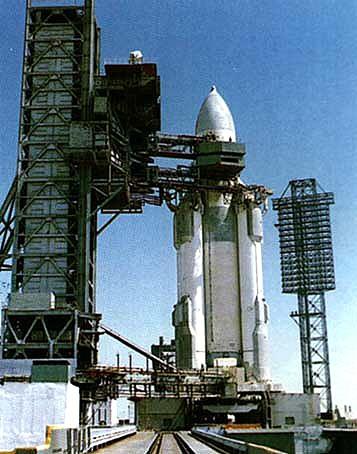

Fwd view of Energia Forward view of Energia launch vehice in assembly hall at MIK Credit: © Mark Wade. 56,386 bytes. 575 x 386 pixels. |
The Energia-Buran Reusable Space System (MKS) was developed as a system that would duplicate the capabilities of the US shuttle system. This decision was taken on 12 February 1976 by the Soviet leadership (Brezhnev, Ustinov, Keldysh) following the loss of the moon race to America. This had pointed to serious deficiencies in the technology base of the Soviet Union. The time-honoured Soviet method of rectifying such situations was to copy the foreign technology. The Buran decision was contrary to the opinions of the Soviet Chief Designers, who favoured smaller reusable ballistic capsules or spaceplanes, and the Soviet military, which preferred a new family of modular, lower-tech, expendable launch vehicles.
Following extended development, Buran made a remarkably successful first unmanned flight on 15 November 1988, four years late to schedule. But the it would never fly again. The Soviet Union was crumbling, and the ambitious plans to build an orbiting defence shield, to renew the ozone layer, dispose of nuclear waste, illuminate polar cities, colonise the moon and Mars, were not to be. Funding dried up and the Buran program completely disappeared from the government's budget after 1993.
The Energia-Buran Reusable Space System (MKS) had its origins in NPO Energia studies of 1974 to 1975 for a 'Space Rocket Complex Program'. In 1974 the N1-L3 heavy lunar launch vehicle project was cancelled and Glushko was appointed chief designer of the new NPO Energia enterprise, replacing Mishin as the head of the former OKB-1. At the same time in the United States development work was underway on the space shuttle. The US Defence Department planned to use the shuttle for a range of military missions. The Soviet military, seeking strategic parity, wished development in the Soviet Union of a reusable manned spacecraft with analogous tactical-technical characteristics. The success of Apollo and the failure of the N1-L3 program pointed to serious deficiencies in the technology base of the Soviet Union. The time-honoured Soviet method of rectifying such situations was to copy the foreign technology.
![]() | Energia - Energia Launch Vehicle erected on the pad 34,578 bytes. 357 x 454 pixels. |
The Soviet Union at this point had no experience in production of large solid rocket motors, especially segmented solid rocket motors of the type used on the shuttle. Glushko favoured a launch vehicle with parallel liquid propellant boosters. These would use a 700 tonne thrust four-chamber Lox/Kerosene engine already under development.
The high chamber pressure, closed-cycle, reusable 230 tonne thrust Lox/LH2 main engine being developed for the shuttle was well outside engineering experience in the Soviet Union. No engine using these cryogenic propellants had ever been used in Russian rockets, and the largest such engine under development was the 40 tonne thrust 11D57. Glushko believed that while a Soviet cryogenic engine of 200 tonnes thrust could be developed in the required time, to develop a reusable engine would be impossible due to limited experience with the propellants.
This conclusion led to other important design decisions. If only expendable engines were to be used, there was no need to house them in the re-entry vehicle for recovery. This meant that the orbiter itself could be moved from the lateral mounting of the space shuttle to an on-axis position at the top of the rocket core. The result was the Vulkan - a classic Soviet launch vehicle design: booster stages arranged around a core vehicle, with the payload mounted on top. The elimination of the lateral loads resulted in a lighter booster, and one that was much more flexible. The vehicle could be customised for a wide range of payloads by the use of from two to eight booster stages around a core equipped with from one to four modular main engines. Either a payload container for heavy payloads (Glushko's LEK lunar base) or the military's required spaceplane could be placed on the nose as the payload.

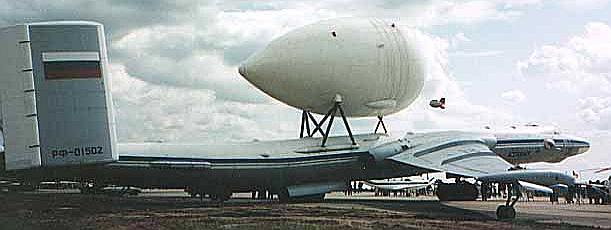

![]() | Myasishchyev VMT-4 - Myasishchyev VMT-2 with Energia liquid oxygen tank 25,850 bytes. 611 x 230 pixels. |
The government decree 132-51 authorising development of the Energia-Buran system was issued on 12 February 1976 with the title 'On development of an MKS (reusable space system) consisting of rocket stages, orbiter aircraft, inter-orbital tug, guidance systems, launch and landing facilities, assembly and repair facilities, and other associated facilities, with the objective of placing in a 200 km Northeast orbit a payload of 30 tonnes and returning a payload of 20 tonnes'. The Ministry of Defence was named the Program Manager, with NPO Energia as the prime contractor. The official military specification (TTZ) was issued at the same time with the code name Buran (the name Energia for the launch vehicle separately did not come into use until just before the launch). A declaration of the Presidium on 18 December 1976 directed co-operation between all concerned user, research, and factory organisations in realising the project. Chief Constructor within NPO Energia was I N Sadovskiy. Chief Designer for the launch vehicle was Y P Kolyako and for the orbiter P V Tsybin. NPO Yuzhnoye in the Ukraine would build the booster rockets.
The Vulkan was used as a starting point, but modified to meet this requirement. Wind tunnel tests were conducted on a wide range of possible arrangements of rocket stages and orbiter positions. In the end, Buran was moved to the lateral position, as with the US space shuttle. The main engines, for the reasons given earlier, remained in the core vehicle. The liquid boosters were retained, but reduced to four in number. After being re-stressed for the lateral launch loads, the resulting Energia launch vehicle had half the lift-off mass and payload of the Vulkan. This was sufficient to carry the Buran with its required internal payload of 30 tonnes.
![]() | Aft view of Energia - Aft view of Energia launch vehice in assembly hall at MIK Credit: © Mark Wade. 63,750 bytes. 362 x 478 pixels. |
The approved launch vehicle layout consisted of the core Block Ts stage, surrounded by 4 Block A liquid propellant boosters and the Buran orbiter or a payload canister. During assembly, transport, and on the pad these were attached to a Block Ya launch services module, which provided all pneumatic, electrical, hydraulic, and other services to the vehicle prior to launch.
The modular Energia design could be used for payloads of from 10 to 200 tonnes using various combinations of booster stages, numbers of modular main engines in the core stage, and upper stages. The version with two booster stages was code-named Groza; with four booster stages, Buran; and the six-booster stage version retained the Vulkan name. The 7.7 meter diameter of the core was determined by the maximum size that could be handled by existing stage handling equipment developed for the N1 programme. The 3.9 meter diameter of the booster stages was dictated by the maximum size for rail transport from the Ukraine.
![]() | Energia strap-ons - Energia launch vehicle strap-ons in assembly hall at MIK Credit: © Mark Wade. 36,789 bytes. 593 x 249 pixels. |
Another factor may have been that the propellants of the core were going to be cryogenic anyway. Lox/Kerosene propellants for the core were considered, but a primary objective of the project was to seek technological parity with the United States by exploiting technologies developed there. Chief among these in the field of liquid fuel rocketry was the use of Lox/LH2 propellants. Therefore the engines of the core were based on the Space Shuttle Main Engine (SSME) of the USA, with the same thrust rating and specific impulse specifications.
Although the SSME may have been the starting point, Soviet engine technology led that of the United States in many other detailed points of liquid rocket design. By the mid-1960's the USA had practically abandoned development of liquid fuel engines, with the sole exception of the SSME. The US military preferred to use solid rocket motors for missile and booster stage applications. Russian rocket engineers had spent their entire lives perfecting military liquid fuel rockets and had never favoured solid fuel. Therefore Russian Liquid Oxygen/Kerosene and N2O4/UDMH engines were of much higher performance than those in the US. The contribution of unique Soviet technology and the inevitable changes that occurred during development resulted in the MKS RD-0120 main engine being different in detail from the SSME while retaining the same performance.
![]() | Clustered Booster - Clustered Launch Vehicle concept, similar to American ALS Credit: © Mark Wade. 8,491 bytes. 107 x 369 pixels. |
By contrast the RD-170 engine for the booster stage was a purely Soviet design and experienced a slow and difficult development program. These were exactly the kind of closed-cycle liquid oxygen/kerosene engines that Glushko had opposed developing in the 1960's. In addition the TTZ required that they be reusable for ten missions. Glushko fell back on his old solution when being unable to handle combustion stability problems: an engine unit consisting of four chambers fed by common turbopumps. Providing adequate wall cooling for the high temperature / high pressure combustion chambers seemed at times insoluble. One problem followed another and finally the RD-170 became the pacing item, with rocket stages completed but lacking engines. As costs reached the project ceiling, Glushko and Minister Afanasyev had to escalate the fight to the highest levels of the Soviet leadership. But Glushko defended his people, retained his job, and the problems were eventually solved.
The Block A 11S25 booster stages were the responsibility of KB Yuzhnoye in the Ukraine, F Utkin, General Constructor. They were to be reused ten times, and were therefore fitted with parachute containers. Solid fuel soft landing rockets in the parachute lines provided a soft landing downrange. It's not clear how the 35 tonne boosters were to be transported back to base for reuse.
![]() | Energia strapons - Energia strapons in the assembly building Credit: © Mark Wade. 65,607 bytes. 575 x 396 pixels. |
The OK-ML-1 orbiter mock-up arrived atop the 3M-T at Baikonur in December 1983. OK-ML-1 was used for handling and pad compatibility tests. It was followed by the OK-MT in August 1984. This functional mock-up was used for systems integration tests, and was to be expended on the second test flight.
From March-October 1985 the Ts core stage was back on the UKSS for cold flow tests. A total of nine cryogenic fuelling cycle were completed with the 4M Energia mock-up, representing the first operational use in the world of super-chilled hydrogen.
In early 1986 came what was to be the first 20 second Energia main engine firing test. This was terminated at 2.58 seconds when the automatic control system detected a slow spool up of an engine turbine. In a the first attempt at a full-duration test helium leaks contaminated electro-hydraulic systems, leading to a situation where the tanks could not be drained. An engineering brigade had to work on the fuelled booster for 55 minutes, attach another helium tank, which led to successful de-fuelling of the vehicle. The second engine test was a complete success, the engine running for 390 seconds. This test required the entire city of Leninsk to be without water for ten days in order to accumulate enough water for the UKSS cooling system.
![]() | Energia booster - Energia launch vehicle variants Credit: © Mark Wade. 15,789 bytes. 763 x 438 pixels. |
In August-September 1986 further UKSS tests of Energia were conducted in preparation of a test launch without Buran. These were conducted using a dummy payload and solid rocket motors to simulate loads from the booster rockets. Following this vehicle 6SL was selected for the first actual launch. The launch vehicle used by itself without Buran was named Energia by Glushko only just before the launch. Energia was to deliver the military Skif-DM Polyus battle station into orbit. This was to be followed by ten flights of Energia-Buran, only the first of which was to be unpiloted.
Due to delays in completion of the enormous static test facility at Baikonur, which could test the entire Energia vehicle stack, it was decided to launch the vehicle without the verification the tests would provide. The launch of 6SL was planned for 11 May 1987 at 21:30 Moscow time. It was delayed five days when a leak was detected in the Block 3A electrical distribution section, then by another hour due to a fault LH2 thermostat. The launch vehicle performed successfully, but the payload failed to inject itself into orbit due to a guidance system failure.

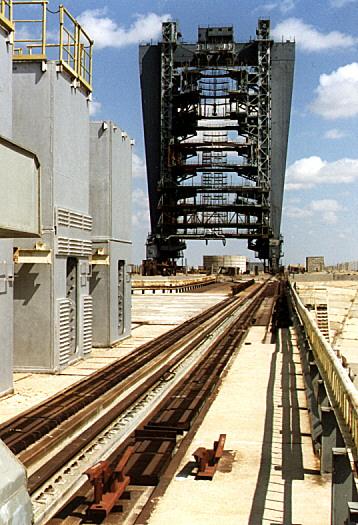

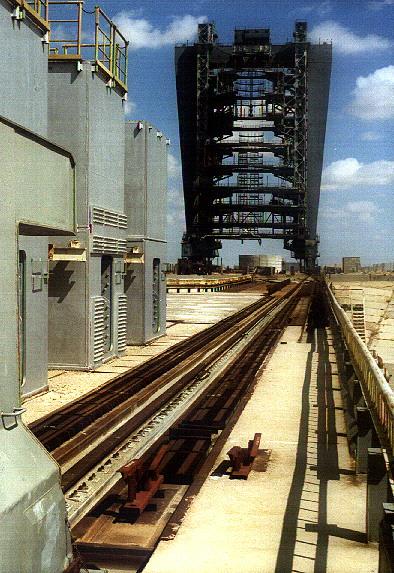

![]() | Energia launch pad - Energia launch complex Credit: © Mark Wade. 15,544 bytes. 355 x 202 pixels. |
But this triumph was also the last hurrah. Energia would never fly again. The Soviet Union was crumbling, and the ambitious plans to use Energia to build an orbiting defence shield, to renew the ozone layer, dispose of nuclear waste, illuminate polar cities, colonise the moon and Mars, were not to be. Funding dried up and the Buran program completely disappeared from the government's budget after 1993.
![]() | Energia pad 1 Credit: © Mark Wade. 26,358 bytes. 257 x 480 pixels. |
Had the Soviet Union not fallen and the Energia booster gone into production, huge projects were planned to take advantage of its capabilities to realize Soviet military and international space goals. These included:
Over 232 experimental test stands were built during Energia development.
Rigorous qualification tests were conducted of all structural components. Structural and functional elements were tested individually, and then in ever larger assemblies. The result was that the flight data very closely followed predictions, and both the launch vehicle and orbiter flew successfully on their very first flights. This was in sharp contrast to the numerous early failures of the Soyuz and N1 programmes in the 1960's.
![]() | Energia pad 2 Credit: © Mark Wade. 62,171 bytes. 394 x 573 pixels. |
Energia Assembly / Processing / Launch / Landing Facilities
Using the N1 facilities at Baikonur as a starting point, major modifications had to be made and several new buildings erected to assemble and launch Buran at the remote Baikonur cosmodrome. The land-locked location of Baikonur meant that major assembly work on the orbiter and launch vehicle had to be conducted on site, instead of at the subcontractors factories. The liquid oxygen and liquid hydrogen tanks of the core, and the Buran orbiters, were flown to Baikonur on the back of the 3M-T transport. The booster stages and all other material and equipment were brought in by rail.
Major Buran facilities at Baikonur, in the order of their occurrence in the orbiter process flow, were:

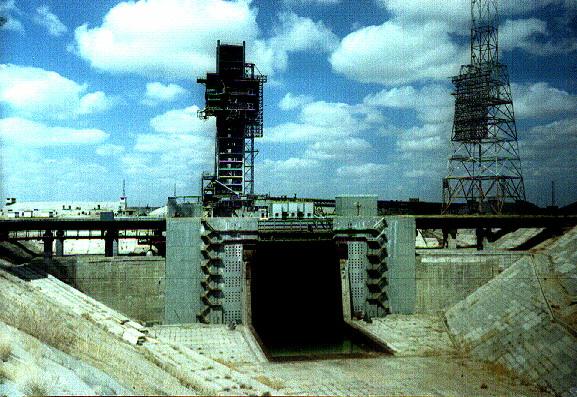

![]() | Energia pad 3 Credit: © Mark Wade. 62,226 bytes. 577 x 397 pixels. |
Launches: 2. Failures: 1. Success Rate: 50.00% pct. First Launch Date: 15 May 1987. Last Launch Date: 15 November 1988. LEO Payload: 88,000 kg. to: 200 km Orbit. Payload: 22,000 kg. to a: geosynchronous orbital trajectory. Liftoff Thrust: 3,582,250 kgf. Total Mass: 2,524,600 kg. Core Diameter: 7.8 m. Total Length: 97.0 m. Flyaway Unit Cost $: 764.00 million. in 1985 unit dollars.

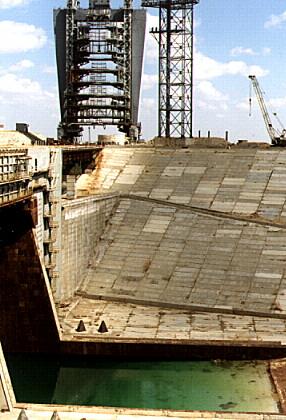

![]() | Flame pit of Energia - Flame pit of Energia combination launch / static test pad. The city of Leninsk had to go without water for a week to support each launch. Credit: © Mark Wade. 30,510 bytes. 286 x 420 pixels. |
Military-Industrial Commission (VPK) Decree 'On Carrying out Work on Reusable Space Systems-response to NASA's Space Shuttle' was issued.
Development of the Block Sr for the N1M cancelled; work on the smaller Block R LH2/LOX stage was resumed. This stage was eventually to have been used on the Buran / Vulkan launch vehicles.

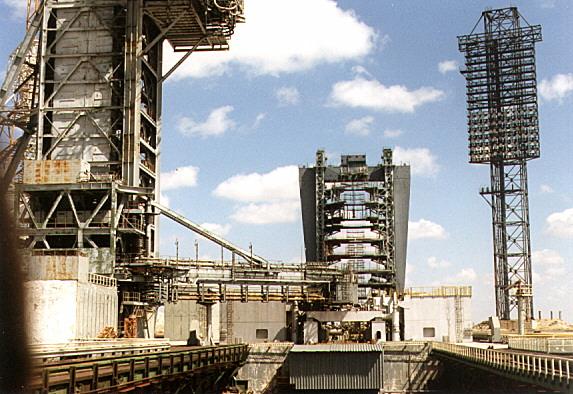

![]() | Energia pad - Mobile service gantry at the Energia pad Credit: © Mark Wade. 50,910 bytes. 358 x 525 pixels. |
Central Committee of the Communist Party and Council of Soviet Ministers Decree 'On work on Energia-Buran, DOS-7K nos. 7 and 8, Gamma. Geyzer (Potok), and Altair (Luch) and cancellation of the N1' was issued. The design of an improved model of the Salyut DOS-17K space station was authorised as part of the third generation of Soviet space systems in a decree. At that time it was planned that the two stations (DOS-7 and DOS-8) would be equipped with two docking ports at either end of the station and an additional two ports at the sides of the forward small diameter compartment. Luch and Potok were elements of the second generation global command and control system (GKKRS) deployed in the first half of the 1980's. Luch satellites, analogous to the US TDRS, provided communications service to the Mir space station, Buran space shuttle, Soyuz-TM spacecraft, military satellites, and the TsUPK ground control center. They also served to provide mobile fleet communications for the Soviet Navy.
![]() | Energia pad - Mobile service gantry at the Energia pad Credit: © Mark Wade. 58,475 bytes. 573 x 394 pixels. |
Decree 'On selection of design layout for Buran' was issued. Following exhaustive analysis and inability to improve on the design, a straight aerodynamic copy of the US space shuttle, was selected as the Buran orbiter configuration. MiG was selected as subcontractor to build the orbiter. For this purpose MiG spun off a new design bureau, Molniya, with G E Lozino-Lozinskiy as chief designer.
Decree 'On course of work on nuclear rocket engines' was issued. The 11B97 stage would have an electric capacity of 500-600 kW and would use specialised plasma-ion electric engines using standing plasma waves and anodes. It was powered from a reactor with a 200 litre core containing 30 kg of uranium fuel. In 1978 this engine was studied for use as a reusable interorbital space tug for launch by Energia-Buran.
From 1976 to 1977 two Block R stages underwent thorough tests of all of their systems. The Block R could have operated up to 7 hours with 7 restarts. Not adopted for production for unknown reasons.
![]() | Energia liftoff - Energia liftoff with Polyus Credit: RKK Energia. 14,283 bytes. 313 x 239 pixels. |
Military-Industrial Commission (VPK) Decree 'On course of work on Energia-Buran' was issued. The declaration of the Presidium directed co-operation between all concerned user, research, and factory organisations in realising the project. Chief Constructor within NPO Energia was I N Sadovskiy. Chief Designer for the launch vehicle was Y P Kolyako and for the orbiter P V Tsybin. NPO Yuzhnoye in the Ukraine would build the booster rockets.
A critical step in any Soviet project, this approved the design and paved the way for development to begin.
The government decree 1006-323 set out the development plan. The flight test plan was for first launch of the booster in 1983, with the payload being an unmanned OK-ML-1 mock-up of the orbiter. This would not have a heat shield and remain attached to the booster. A second mock-up, OK-ML-2, would be used on the second launch, but be separated from the vehicle after burnout. However it would also be without heat shield, and be expended. The first flight Buran was to fly unpiloted in 1984. Manned flights were to be routine by the 1987 seventieth anniversary of the Soviet Union.
![]() | Energia Credit: Mark Wade. 33,392 bytes. 640 x 344 pixels. |
3M bomber was selected to carry piggy-back Energia core stage components and Buran orbiters.
The technical project was completed in May 1978. The flight test plan at the beginning of the project foresaw first launch of the booster in 1983, with the payload being an unmanned OK-ML-1 mock-up of the orbiter. The first flight Buran was to fly unpiloted in 1984. Manned flights were to be routine by the 1987 seventieth anniversary of the Soviet Union.
Buran engineering details were definitised and drawing release began to the production shops.
The EUK13 dimensional model of the launch vehicle was delivered to Baikonur for handling demonstrations and production of tooling.
![]() | Energia LV Credit: © Mark Wade. 3,637 bytes. 125 x 431 pixels. |
NPO Energia developed for the Ministry of Defence the interorbital tug Gerkules with 550 kW maximum output and continuous operation in the 50-150 kW range for 3 to 5 years. In 1986 an interorbital tug was studied to solve the specific application of transporting heavy satellites of 100 tonnes to geostationary orbit, launched by Energia.
Continued development problems with the booster rockets led to a management shake-up at Yuzhnoye in January 1982. By this time the project was several years behind schedule. The originally planned first flight in 1983 was obviously unattainable.
First test of the modified 3M bomber, converted to carry piggy-back Energia core stage components and Buran orbiters.
![]() | Energia booster - Energia launch vehicle Credit: © Mark Wade. 3,810 bytes. 134 x 464 pixels. |
During 1982 the 3M-T transport aircraft was completed and began delivery of central block propellant tanks and structural elements for construction of a realistic mock-up of the booster.
The 4M Energia launch vehicle high fidelity mock-up was completed at Baikonur.
The 3M-T transport aircraft was completed and began delivery of central block propellant tanks and structural elements for construction of a realistic mock-up of the Energia booster. The 3M-T was a heavily modified M-4 bomber, and was limited to 50 tonnes loads carried on the top of the fuselage.
The 4M Energia mock-up was subjected to dynamic / vertical / load tests in May-October 1983. The 4M was then returned to the shop for fitting of complete functional propellant systems.
![]() | Energia with Polyus - Energia with Polyus payload Credit: © Mark Wade. 4,088 bytes. 121 x 464 pixels. |
The OK-KS Buran systems test stand was built at NPO Energia to conduct tests not possible on other stands. These included electrical layout, pneumo-hydraulic tests in abort conditions, EMI tests, failure mode response, telemetry, interface with the launch vehicle, software systems test.
The OK-ML-1 orbiter mock-up arrived atop the 3M-T at Baikonur. This action seems to have been in the fine Soviet tradition of individual enterprises proving they have met the plan, even if the method of doing it is useless. OK-ML-1 was to have been used in the first launch of the Energia, by the end of 1983. By delivering it to Baikonur by December 31, the spacecraft builders could claim, 'well, we met OUR part of the plan...'). OK-ML-1 was used for handling and pad compatibility tests.
The OK-ML-1 mock-up arrived atop the 3M-T transport aircraft. OK-ML-1 was originally to have been used in the first launch of the Energia, by the end of 1983. But the program was years behind schedule, and in the end the OK-ML-1 was used for handling and pad compatibility tests.
The OK-ML-2 (former OK-MT) functional mock-up was used for systems integration tests, and was to have been expended on the second test flight.
From March-October 1985 the Ts core stage was back on the UKSS for cold flow tests. A total of nine cryogenic fuelling cycle were completed with the 4M Energia mock-up, representing the first operational use in the world of super-chilled hydrogen.
From March-October 1985 the Ts core stage was back on the UKSS test/launch stand for cold flow tests. A total of nine cryogenic fuelling cycle were completed with the 4M Energia mock-up, representing the first operational use in the world of super-chilled hydrogen.
In December 1985 the wings of the first flight OK arrived at Baikonur. This was followed by what was to be the first 20 second Energia main engine firing test. This was terminated at 2.58 seconds when the automatic control system detected a slow spool up of an engine turbine. In a the first attempt at a full-duration test helium leaks contaminated electro-hydraulic systems, leading to a situation where the tanks could not be drained. An engineering brigade had to work on the fuelled booster for 55 minutes, attach another helium tank, which led to successful de-fuelling of the vehicle. The second engine test was a complete success, the engine running for 390 seconds. This test required the entire city of Leninsk to be without water for ten days in order to accumulate enough water for the UKSS cooling system.
By January 1986 it was clear that the project, now three years behind schedule, had no prospect of completion due to problems in obtaining deliveries of equipment for Buran, numerous problems in assembling the orbiters and lack of manpower at Baikonur, and a general loss of management focus. Minister O D Bakhnov called large group of industry leaders to the cosmodrome to review measures to concentrate and accelerate the remaining work. Three 'Tiger Teams' were set up. The first, led by Semenov, was to finish the flight Buran orbiter and associated facilities in time for a third quarter 1987 launch. The second, led by B I Gubanov, was to finish the Energia launch vehicle and fly it, without the Buran mock-ups if necessary, at the earliest possible date. The third group, led by S S Banin, was to complete the assembly and launch facilities.
By January 1986 it was clear that the project, now three years behind schedule, had no prospect of completion due to problems in obtaining deliveries of equipment for Buran, numerous problems in assembling the orbiters and lack of manpower at Baikonur, and a general loss of management focus. Minister O D Bakhnov called a large group of industry leaders to the cosmodrome to review measures to concentrate and accelerate the remaining work. Three 'Tiger Teams' were set up. The first, led by Semenov, was to finish the flight Buran orbiter and associated facilities in time for a third quarter 1987 launch. The second, led by B I Gubanov, was to finish the Energia launch vehicle and fly it, without the Buran mock-ups if necessary, at the earliest possible date. The third group, led by S S Banin, was to complete the assembly and launch facilities.
This was to be the first 20 second Energia main engine firing test. It was terminated at 2.58 seconds when the automatic control system detected a slow spool up of an engine turbine. In a the first attempt at a full-duration test helium leaks contaminated electro-hydraulic systems, leading to a situation where the tanks could not be drained. An engineering brigade had to work on the fuelled booster for 55 minutes, attach another helium tank, which led to successful de-fuelling of the vehicle.
Tests of the orbiter's ODU engine unit uncovered an apparent defect in gaseous oxygen valves of the reaction control system. Although it threatened to delay flight of the Buran, it was eventually discovered to be a software problem and remedied within days.
A Polyus mock-up was delivered by the Krunichev Factory to Baikonur Cosmodrome, for tests of the Polyus/Energia interface. The spacecraft was about 37 meters in length, 4.1 meters in diameter and weighed about 80 metric tons.
Further UKSS tests of Energia were conducted in preparation of a test launch without Buran. These were conducted using a dummy payload and solid rocket motors to simulate loads from the booster rockets. Following this vehicle 6SL was selected for the first actual launch. The launch vehicle used by itself without Buran was named Energia by Glushko only just before the launch.
Following the decision to make the first flight of Energia without a Buran orbiter, in August-September 1986 further UKSS tests of Energia were conducted. These used a dummy payload and solid rocket motors to simulate loads from the booster rockets.
The second engine test was a complete success, the engine running for 390 seconds. This test required the entire city of Leninsk to be without water for ten days in order to accumulate enough water for the UKSS cooling system.
Energia was to deliver the military Skif-DM Polyus battle station into orbit. Due to delays in completion of the enormous static test facility at Baikonur, which could test the entire Energia vehicle stack, it was decided to launch the vehicle without the verification the tests would provide. The launch of 6SL was planned for 21:30 Moscow time. It was delayed five hours when a leak was detected in the Block 3A electrical distribution section, then by another hour due to a fault LH2 thermostat. The launch vehicle performed successfully, but the payload failed to inject itself into orbit due to a guidance system failure.
Due to delays in completion of the enormous static test facility at Baikonur, which could test the entire Energia vehicle stack, it was decided to launch the vehicle without the verification the tests would provide. The launch of 6SL was planned for 11 May 1987 at 21:30 Moscow time. It was delayed five days when a leak was detected in the Block 3A electrical distribution section, then by another hour due to a fault LH2 thermostat. The launch vehicle performed successfully, but the Polyus payload failed to inject itself into orbit due to a guidance system failure.
The launch commission met on 26 October 1988 and set 29 October 06:23 Moscow time for the first flight of the first Buran orbiter (Flight 1K1).
51 seconds before the launch, when control of the countdown switched to automated systems, a software problem led the computer program to abort the lift-off. The problem was found to be due to late separation of a gyro update umbilical. The software problem was rectified and the next attempt was set for 15 November at 06:00 (03:00 GMT).
The weather was snow flurries with 20 m/s winds. Launch abort criteria were 15 m/s. The launch director decided to press ahead anyway. After 12 years of development everything went perfectly. Buran, with a mass of 79.4 tonnes, separated from the Block Ts core and entered a temporary orbit with a perigee of -11.2 km and apogee of 154.2 km. At apogee Burn executed a 66.6 m/s manoeuvre and entered a 251 km x 263 km orbit of the earth. In the payload bay was the 7150 kg module 37KB s/n 37071. 140 minutes into the flight retrofire was accomplished with a total delta-v of 175 m/s. 206 minutes after launch, accompanied by Igor Volk in a MiG-25 chase plane, Buran touched down at 260 km/hr in a 17 m/s crosswind at the Jubilee runway, with a 1620 m landing rollout. The completely automatic launch, orbital manoeuvre, deorbit, and precision landing of an airliner-sized spaceplane on its very first flight was an unprecedented accomplishment of which the Soviets were justifiably proud. It completely vindicated the years of exhaustive ground and flight test that had debugged the systems before they flew.
Unmanned test of Soviet shuttle. Landed November 15, 1988 06:25 GMT. Buran was first moved to the launch pad on 23 October 1988. The launch commission met on 26 October 1988 and set 29 October 06:23 Moscow time for the first flight of the first Buran orbiter (Flight 1K1). 51 seconds before the launch, when control of the countdown switched to automated systems, a software problem led the computer program to abort the lift-off. The problem was found to be due to late separation of a gyro update umbilical. The software problem was rectified and the next attempt was set for 15 November at 06:00 (03:00 GMT). Came the morning, the weather was snow flurries with 20 m/s winds. Launch abort criteria were 15 m/s. The launch director decided to press ahead anyway. After 12 years of development everything went perfectly. Buran, with a mass of 79.4 tonnes, separated from the Block Ts core and entered a temporary orbit with a perigee of -11.2 km and apogee of 154.2 km. At apogee Burn executed a 66.6 m/s manoeuvre and entered a 251 km x 263 km orbit of the earth. In the payload bay was the 7150 kg module 37KB s/n 37071. 140 minutes into the flight retrofire was accomplished with a total delta-v of 175 m/s. 206 minutes after launch, accompanied by Igor Volk in a MiG-25 chase plane, Buran touched down at 260 km/hr in a 17 m/s crosswind at the Jubilee runway, with a 1620 m landing rollout. The completely automatic launch, orbital manoeuvre, deorbit, and precision landing of an airliner-sized spaceplane on its very first flight was an unprecedented accomplishment of which the Soviets were justifiably proud. It completely vindicated the years of exhaustive ground and flight test that had debugged the systems before they flew.
No known mission (with the end of SDI and the cold war) - plus the project manager was one of the 1991 coup plotters. Total cost 20 billion rubles at time of cancellation.
The first Buran payload, 37KB module s/n 37070, arrived in Baikonur. The 37KB modules, similar to the Kvant module of the Mir space station, were to be standard on the early Buran flights. 37KB-37070 itself primarily contained instrumentation to measure the performance of the orbiter and its structure on its first flight.
